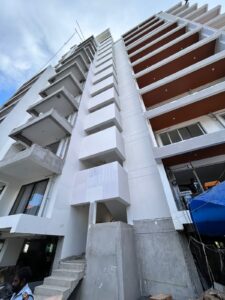

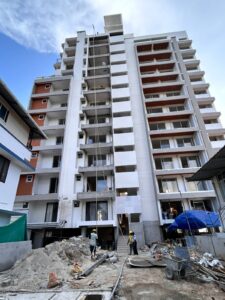

Work Progress of Serene as on 31.08.2026
Electrical wall chasing & rope pulling work
1st to 11th floor-100%
Electrical wire pulling work
1st to13th floor-100%
Plumbing work: Toilet pipe line work
1st–11th floor: 100%
Waterproofing work
1st-11th-100%
Handrail work balcony

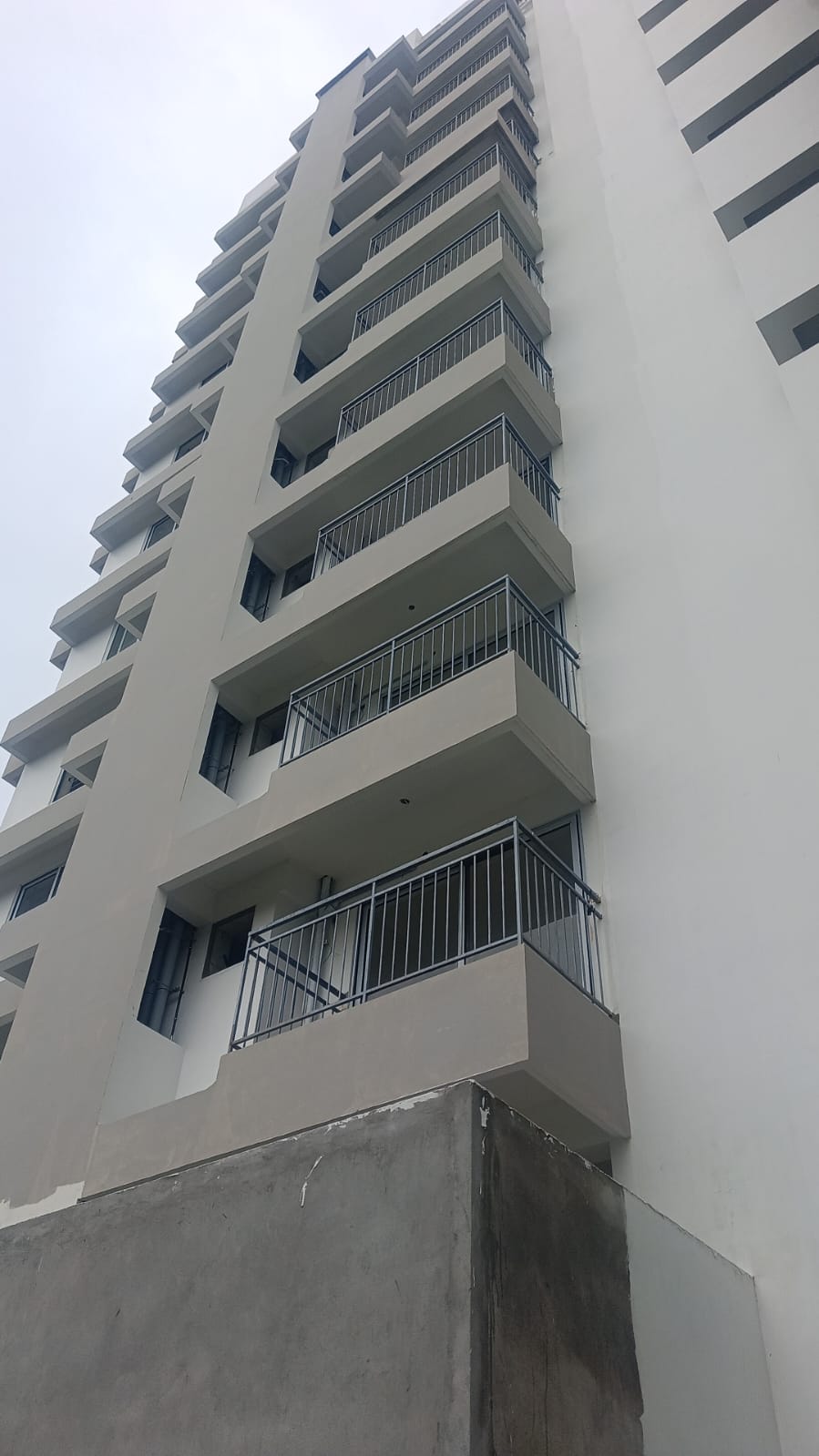

1st-11th-100%
Handrail work staircase
1st-11th-100%
Tiling Work Progress
Floor tile – First to 11th floor- 100%
Toilet tile -1st-11th floor-100%
Painting Work
First-floor-70% Second floor-11th-100%
Gas Line Work
BF-12th FLOOR-95%

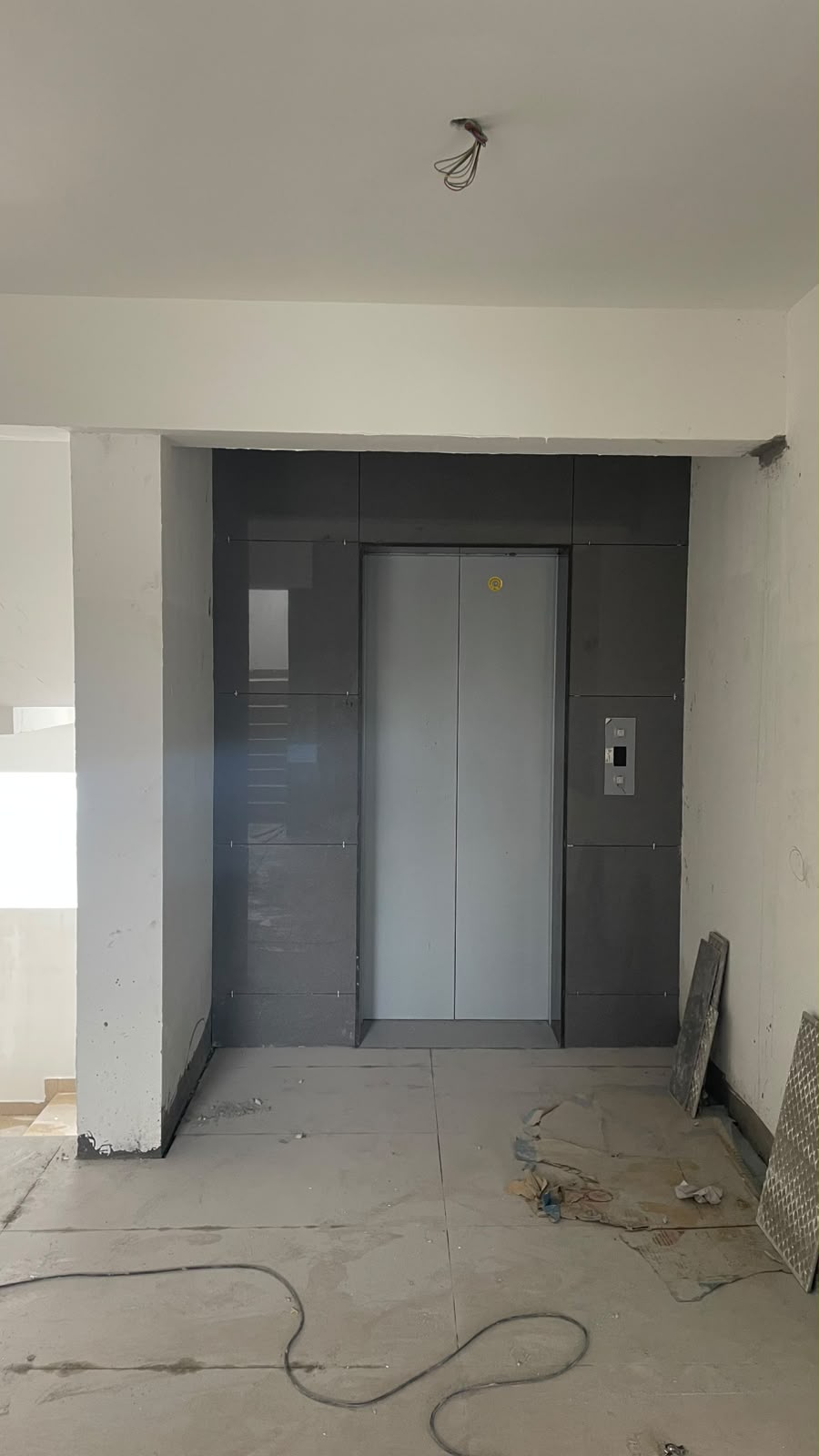

Lift Work
BF-12th FLOOR-95%
HT Work– PANEL BOARD FIXING-100%
Fire Work
PIPELINE-100%
SPRINKLER PIPELEINE-70%

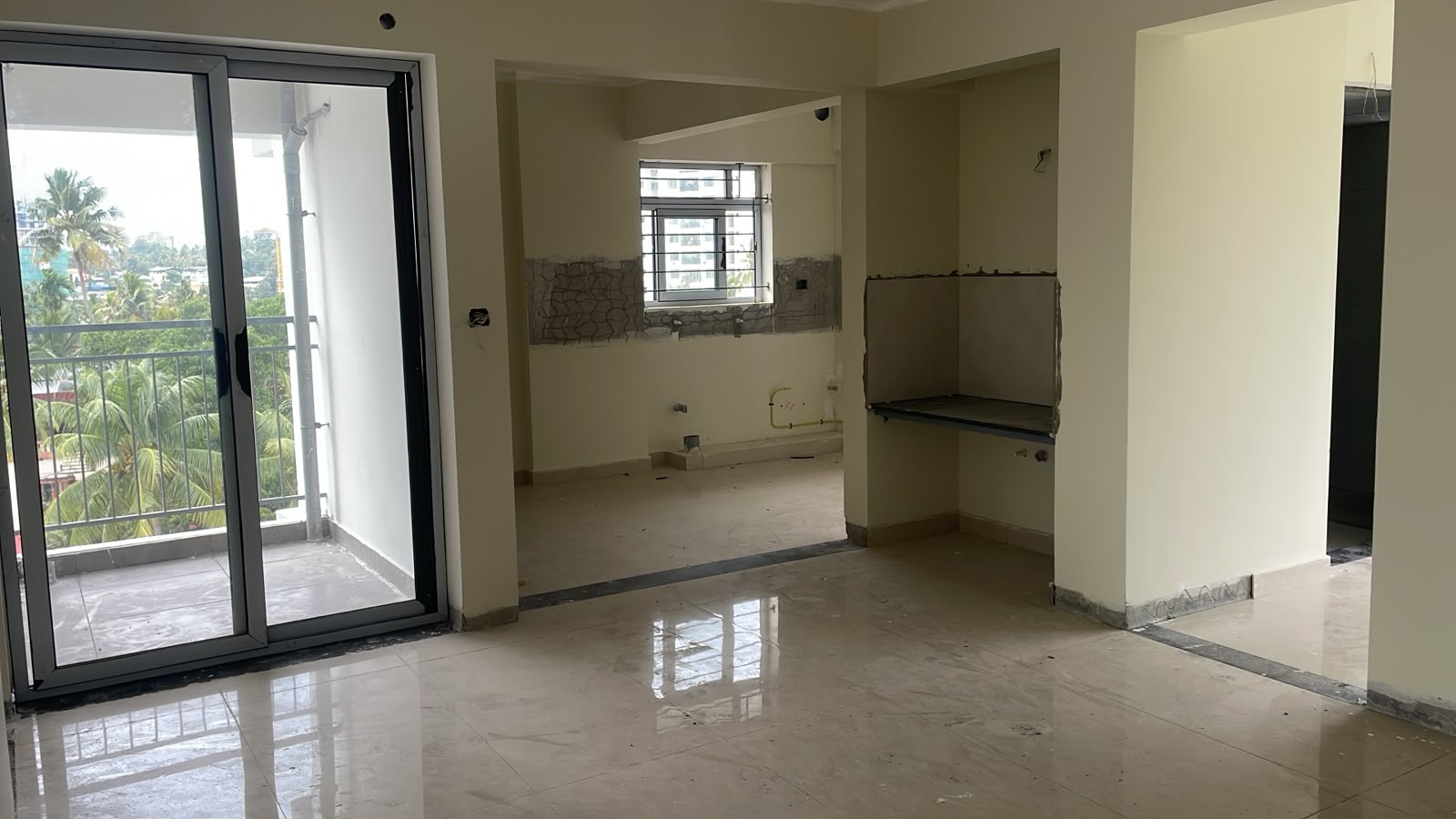

Aluminium Work
1st FLOOR-70%
2nd-11th-90%

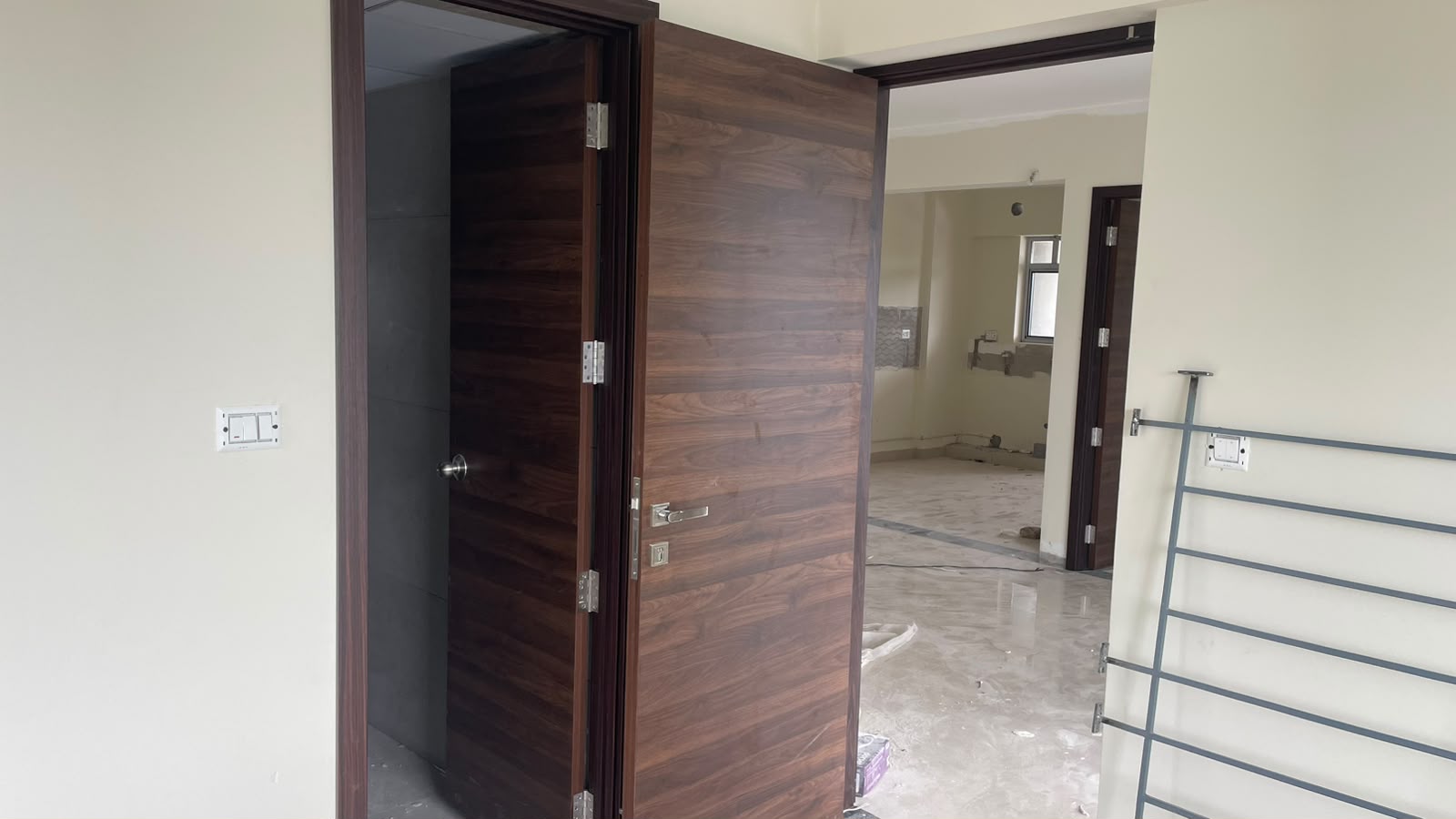

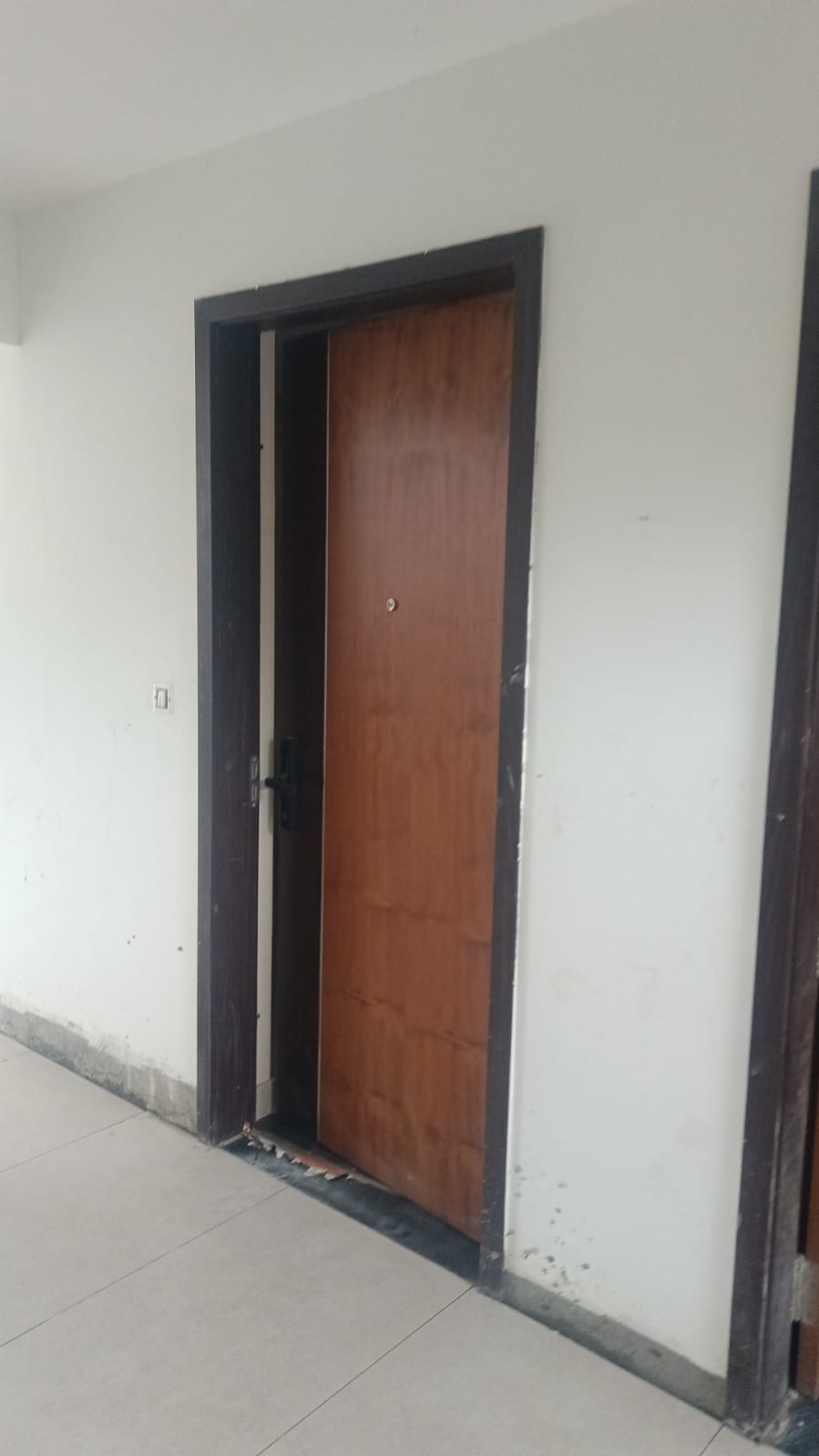

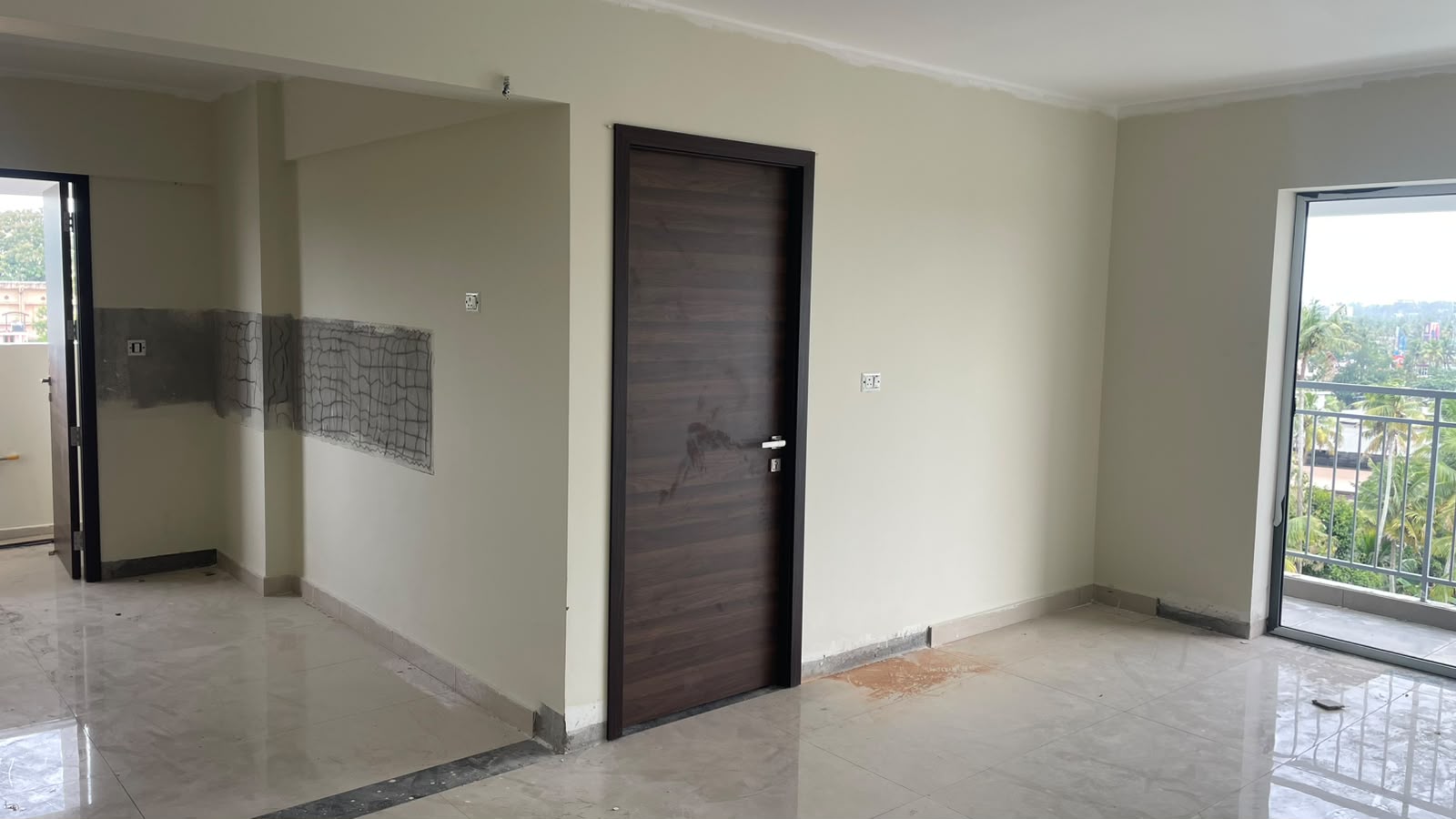

Door Fixing Work
1st, 2nd-70%
3rd-7th-80%
8th-9th-30%

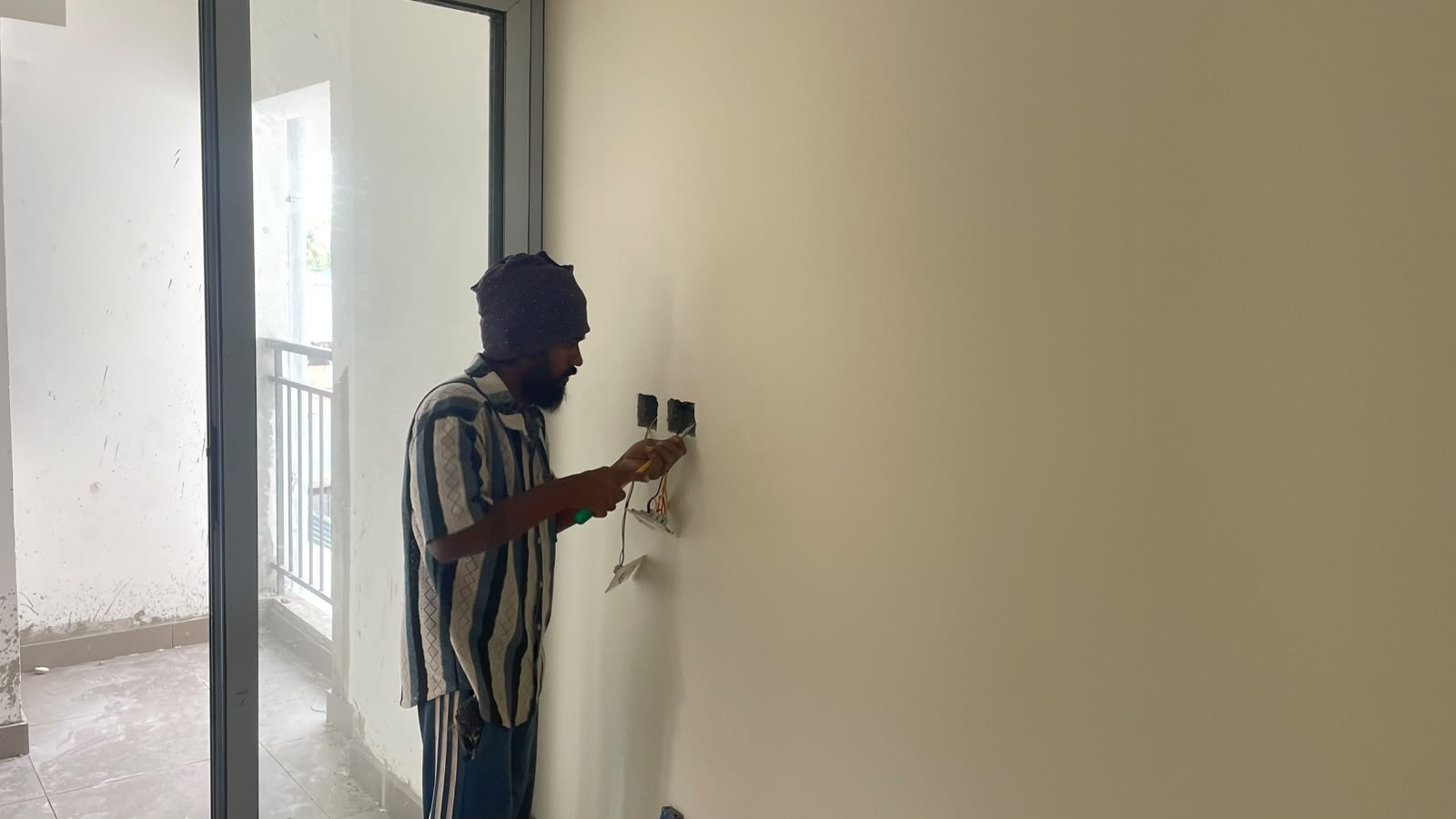

Electrical Switch Fixing
1st -3rd FLOOR-35%
4th-7th FLOOR-70%
8th-11th-35%
Plumbing & Sanitary
1ST FLOOR-35%
Work Progress of SERENE as on 31.07.2026
Work Progress of SERENE as on 30-06-2026
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%
- Grade slab -100%
- Ground floor to Twelfth floor slabs -100%
- Swimming pool slab- 100%
- Head room slab- 100%
- Over Head Tank- 100%

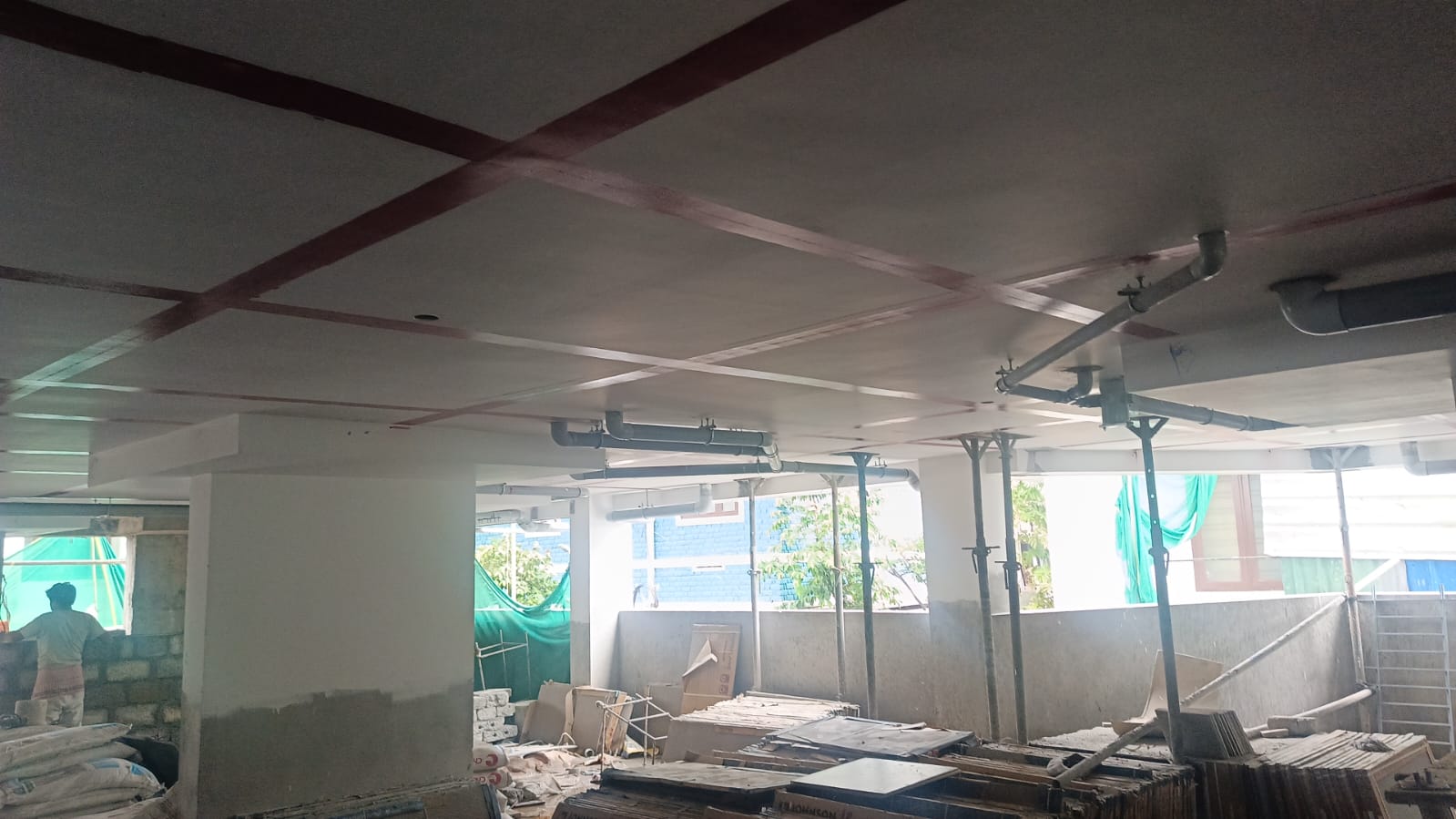

- Ceiling Plastering Work- 100%
Wall Plastering
- First to 11th floor Wall plastering work- 100%
Block Work:
- First to 11th floor block work-100%
- Electrical wall chasing & rope pulling work
1st to 11th floor-100% - Electrical wire pulling work- 1st to 9th floor-67%
- Plumbing work: Toilet pipe line work
1st–11th floor: 100%
Waterproofing work
1st-11th-100%
Handrail work balcony-
1st-11th-100%
Handrail work staircase
1st-11th-100%
TILING WORK PROGRESS
Type A
- First to 9th floor- 80% Completed
Type B
- 1B- 70% Completed
- 2B TO 7B- 40%
Type C
Work Progress of SERENE as on 06.05.2026
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%
- Grade slab -100%
- Ground floor to Twelfth floor slabs -100%
- Swimming pool slab- 100%
- Head room slab- 100%
- Over Head Tank- 100%
- Ceiling Plastering Work- 100%
Wall Plastering
- First to 11th floor Wall plastering work- 100%
Block Work:
- First to 11th floor block work-100%
- Electrical wall chasing & rope pulling work
1st to 11th floor-100% - Electrical wire pulling work- 1st to 9th floor-67%
- Plumbing work: Toilet pipe line work
1st–11th floor: 100%
Waterproofing work
1st-11th-100%
Handrail work balcony-
1st-11th-100%
Handrail work staircase
1st-11th-100%
TILING WORK PROGRESS
Type A
- First to 9th floor- 80% Completed
Type B
- 1B- 70% Completed
- 2B TO 7B- 40%
Type C
Work Progress of SERENE as on 01.04.2026
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%
- Grade slab -100%
- Ground floor to Twelfth floor slabs -100%
- Swimming pool slab- 100%
- Head room slab- 100%
- Over Head Tank- 100%
- Ceiling Plastering Work- 100%
Block Work:
- First to 11th floor block work-100%
- Electrical wall chasing & rope pulling work
1st to 11th floor-100% - Electrical wire pulling work- 1st to 9th floor-67%
- Plumbing work: Toilet pipe line work
1st–11th floor: 100%
First to 11th floor Wall plastering work- 100%
TILING WORK PROGRESS
Type A
- First to 9th floor- 80% Completed
Type B
- 1B- 70% Completed
- 2B TO 7B- 40%
Type C
Work Progress of SERENE as on 11.03.2026
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%Grade slab -100%
- Ground floor to Twelfth floor slabs -100%
- Swimming pool slab- 100%
- Head room slab- 100%
- Over Head Tank- 100%
- Ceiling Plastering Work- 100%
Wall Plastering
- First to 11th floor Wall plastering work- 100%
Block Work:
- First to 11th floor block work-100%
- Electrical wall chasing & rope pulling work- 1st to 11th floor-100%
- Electrical wire pulling work- 1st to 9th floor-67%
Plumbing work: Toilet pipe line work
1st–9th floor: 100%
Tenth floor- 90%
Eleventh floor- 60%
TILING WORK PROGRESS
Type A
- First to 9th floor- 80% Completed
Type B
- 1B- 70% Completed
- 2B TO 7B: 40%
Type C
- 2C,4C TO 9C: 65% Completed
Work Progress of SERENE as on 02.02.2026
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
- Forth Floor slab-100%
- Fifth Floor slab-100%
- Sixth Floor slab-100%
- Seventh Floor slab-100%
- Eighth Floor slab-100%
- Ninth Floor Slab- 100%
- Tenth Floor Slab- 100%
- Eleventh Floor Slab- 100%
- Twelfth Floor Slab- 100%
- Swimming pool slab- 100%
- Head room slab- 100%
- Over Head Tank- 100%
- Ceiling Plastering Work- 100%
Wall Plastering
- First to 11th floor Wall plastering work- 100%
Block Work:
- First to 11th floor block work-100%
Work Progress of SERENE as on 02.01.2026
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
- Forth Floor slab-100%
- Fifth Floor slab-100%
- Sixth Floor slab-100%
- Seventh Floor slab-100%
- Eighth Floor slab-100%
- Ninth Floor Slab- 100%
- Tenth Floor Slab- 100%
- Eleventh Floor Slab- 100%
- Twelfth Floor Slab- 100%
- Swimming pool slab- 100%
- Head room slab- 100%
- Over Head Tank- 100%
- Ceiling Plastering Work- 100%
Wall Plastering
Block Work:
Work Progress of SERENE as on 05.12.2025
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
- Forth Floor slab-100%
- Fifth Floor slab-100%
- Sixth Floor slab-100%
- Seventh Floor slab-100%
- Eighth Floor slab-100%
- Ninth Floor Slab- 100%
- Tenth Floor Slab- 100%
- Eleventh Floor Slab- 100%
- Twelfth Floor Slab- 100%
- Swimming pool slab- 100%
- Head room slab- 100%
- Over Head Tank- 100%
Ceiling Plastering Work:
- First to Tenth floor ceiling plastering work- 100%
- Eleventh floor ceiling plastering work- 100%
Wall Plastering
- First to 9th floor Wall plastering work- 100%
- 10th floor wall plastering- 65%
Block Work:
- First to 9th floor block work-100%
- Tenth floor block work- 95%
- 11th floor block work- 60%
Work Progress of SERENE as on 07.11.2025
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
- Forth Floor slab-100%
- Fifth Floor slab-100%
- Sixth Floor slab-100%
- Seventh Floor slab-100%
- Eighth Floor slab-100%
- Ninth Floor Slab- 100%
- Tenth Floor Slab- 100%
- Eleventh Floor Slab- 100%
- Twelfth Floor Slab- 100%
- Swimming pool slab- 100%
- Head room slab- 100%
- Over Head Tank- 30%
Ceiling Plastering Work:
- First to Tenth floor ceiling plastering work- 100%
- Eleventh floor ceiling plastering work- 85%
Wall Plastering
- First to 9th floor Wall plastering work- 100%
- 10th floor wall plastering- 15%
Block Work:
- First to 9th floor block work-100%
- Tenth floor block work- 90%
- 11th floor block work- 20%
Work Progress of SERENE as on 09-10-2025
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
- Forth Floor slab-100%
- Fifth Floor slab-100%
- Sixth Floor slab-100%
- Seventh Floor slab-100%
- Eighth Floor slab-100%
- Ninth Floor Slab- 100%
- Tenth Floor Slab- 100%
- Eleventh Floor Slab- 100%
- Twelfth Floor Slab- 100%
- Swimming pool slab- 100%
- Head room slab- 100%
- Over Head Tank- 30%
Ceiling Plastering Work:
- First to Tenth floor ceiling plastering work- 100%
- Eleventh floor ceiling plastering work- 85%
Wall Plastering
- First to 9th floor Wall plastering work- 100%
- 10th floor wall plastering- 50%
Block Work:
- First to 9th floor block work-100%
- Tenth floor block work- 80%
- 11th floor block work- 50%
Work Progress of SERENE as on 12-09-2025
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
- Forth Floor slab-100%
- Fifth Floor slab-100%
- Sixth Floor slab-100%
- Seventh Floor slab-100%
- Eighth Floor slab-100%
- Ninth Floor Slab- 100%
- Tenth Floor Slab- 100%
- Eleventh Floor Slab- 100%
- Twelfth Floor Slab- 100%
- Swimming pool slab- 30%
Block Work:
- First floor block work-100%
- Second floor block work-100%
- Third floor block work-100%
- Fourth floor block work- 100%
- Fifth floor block work- 100%
- Sixth floor block work- 100%
- Seventh floor block work- 60%
- Eighth floor block work- 85%
- Ninth floor block work- 45%
Ceiling Plastering Work:
- First to Tenth floor ceiling plastering work- 100%
- Eleventh floor ceiling plastering work- 5%
Wall Plastering
- First floor Wall plastering work- 80%
- Second floor Wall plastering work- 80%
- Third floor plastering work- 100%
- Fourth floor wall plastering- 70%
- Fifth floor wall plastering- 100%
- Sixth floor wall plastering- 100%
- Seventh floor wall plastering- 30%
Work Progress of SERENE as on 12.08.2025
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%
- Grade slab -100%
- Ground floor slab -100%
- First Floor Slab – 100%
- Second Floor Slab – 100%
- Third Floor Slab – 100%
- Forth Floor slab-100%
- Fifth Floor slab-100%
- Sixth Floor slab-100%
- Seventh Floor slab-100%
- Eighth Floor slab-100%
- Ninth Floor Slab- 100%
- Tenth Floor Slab- 100%
- Eleventh Floor Slab- 100%
- Twelfth Floor Slab- 100%
- Swimming pool slab- 30%
Wall Plastering
- First floor Wall plastering work- 80%
- Second floor Wall plastering work- 80%
- Third floor plastering work- 100%
- Fourth floor wall plastering- 70%
- Fifth floor wall plastering- 30%
Work Progress of SERENE as on 07.07.2025
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 100%
- Grade slab -100%
- Ground floor slab -100%
- First Floor Slab – 100%
- Second Floor Slab – 100%
- Third Floor Slab – 100%
- Forth Floor slab-100%
- Fifth Floor slab-100%
- Sixth Floor slab-100%
- Seventh Floor slab-100%
- Eighth Floor slab-100%
- Ninth Floor Slab- 100%
- Tenth Floor Slab- 100%
- Eleventh Floor Slab- 100%
- Twelfth Floor Slab- 60%
Ceiling Plastering Work:
First floor ceiling plastering work-100%
Sec floor ceiling plastering work-100%
Third floor Ceiling plastering work-100%
Forth floor ceiling plastering work-100%
Fifth floor ceiling plastering work-100%
Sixth floor ceiling plastering work-100%
Seventh floor ceiling plastering work- 40%
- Wall Plastering
First floor Wall plastering work- 80%
Second floor Wall plastering work- 80%
Third floor plastering work- 30% - Block Work:
First floor block work-95%
Second floor block work-95%
Third floor block work-95%
Fourth floor block work- 95%
Fifth floor block work- 70%
Sixth floor block work- 10%
Work Progress of SERENE as on 08-06-2025
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 75%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
- Forth Floor slab-100%
- Fifth Floor slab-100%
- Sixth Floor slab-100%
- Seventh Floor slab-100%
- Eighth Floor slab-100%
- Ninth Floor Slab- 100%
- Tenth Floor Slab- 100%
- Eleventh Floor Slab- 40%
Block Work:
First floor block work-95%
Second floor block work-95%
Third floor block work-55%
Plastering Work:
First floor ceiling plastering work-100%
Sec floor ceiling plastering work-100%
Third floor Ceiling plastering work-100%
Forth floor ceiling plastering work-100%
Fifth floor ceiling plastering work-100%
Sixth floor ceiling plastering work-20%
First floor Wall plastering work- 35%
Work Progress of SERENE as on 09-05-2025
- Piling Work – 100%
- Pile cap work – 100%
- Retaining wall – 75%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
- Forth Floor slab-100%
- Fifth Floor slab-100%
- Sixth Floor slab-100%
- Seventh Floor slab-100%
- Eighth Floor slab-100%
- Ninth Floor Slab- 100%
- Tenth Floor Slab- 60%
Plastering Work:
First floor ceiling plastering work-90%
Sec floor ceiling plastering work-90%
Third floor Ceiling plastering work-100%
Forth floor ceiling plastering work-95%
Block Work:
First floor block work-85%
Second floor block work-70%
Third floor block work-35%
Work Progress of SERENE as on 03-04-2025
Piling Work – 100%
Pile cap work – 100%
Retaining wall – 75%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
Forth Floor slab-100%
Fifth Floor slab-100%
Sixth Floor slab-100%
Seventh Floor slab-100%
Eighth Floor slab-100%
Ninth Floor slab- 60%
Work Progress of SERENE as on 07-03-2025
Piling Work – 100%
Pile cap work – 100%
Retaining wall – 75%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
Forth Floor slab-100%
Fifth Floor slab-100%
Sixth Floor slab-100%
Seventh Floor slab-100%
Eighth Floor slab-100%
Work Progress of SERENE as on 05-02-2025
Piling Work – 100%
Pile cap work – 100%
Retaining wall – 75%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
Forth Floor slab-100%
Fifth Floor slab-100%
Sixth Floor slab-100%
Seventh Floor slab-60%
Work Progress of SERENE as on 02-01-2025
Piling Work – 100%
Pile cap work – 100%
Retaining wall – 75%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 100%
Forth Floor slab-100%
Fifth Floor slab-100%
Sixth Floor slab-40%
Work Progress of SERENE as on 08-11-2024
Pile cap work – 100%
Retaining wall – 75%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – 100%
Third Floor Slab – 60%
Work Progress of SERENE as on 03-10-2024
Piling Work – 100%
Pile cap work – 100%
Grade slab -100%
Ground floor slab -100%
First Floor Slab – 100%
Second Floor Slab – ongoing
Work Progress of SERENE as on 10-07-2024
Piling Work – 100%
Pile cap work – 98%
Grade slab -100%
Grade slab PCC – 100%
Ground floor slab shuttering and steel works ongoing
Work Progress of SERENE as on 06-06-2024
Piling Work – 100%
Pile Cap Work – 95%
Grade Slab – 45%
Retaining Wall – 65%
Grade Slab PCC – 75%
Work Progress of SERENE as on 04-05-2024
Piling Work – 100%
Pile Cap Work – 95%
Grade Slab – 45%
Work Progress of SERENE as on 27-03-2024
Piling Work – 100%
Pile Cap Work – 86%
Plinth Beam – 15%
Work Progress of SERENE as on 07-02-2024
Piling Work – 100%
Pile chipping work – 30%
Work Progress of SERENE as on 15-11-2023
Piling Work – 100%
Earth Excavation Work – 5%
Work Progress of SERENE as on 19-10-2023
Work Progress of SERENE as on 08-09-2023
