exotica-1
PROJECT TYPE :
Ongoing Projects
PROJECT CATEGORY :
Premium Luxury Apartment
PROJECT LOCATION :
Near KIMS Hospital, Trivandrum
DISTRICT :
Thiruvananthapuram
PERMIT NUMBERS :
ZK2/BA/182/18
K-RERA NUMBER :
K-RERA/PRJ/TVM/085/2022

Arcon Exotica – Luxury 2 & 3 BHK Apartments in Trivandrum by Arcon Homes

Experience the art of fine living with Arcon Exotica, a premium residential project from Arcon Homes, one of the most trusted builders in Trivandrum. Designed for those who seek a perfect balance of luxury, convenience, and comfort, Arcon Exotica redefines modern urban living in Kerala’s vibrant capital city.

Located near KIMS Hospital, this elegant development ensures unmatched accessibility to Trivandrum’s healthcare, educational, and lifestyle hubs. Whether you’re looking to buy apartments in Trivandrum or invest in a premium address, Arcon Exotica offers an ideal home for families, professionals, and investors alike.

Project Highlights

  • 10 floors of modern architecture featuring 57 spacious 2 & 3 BHK apartments

  • Elegant design with superior construction quality and contemporary finishes

  • Prime location near KIMS Hospital, offering exceptional connectivity and urban convenience

  • Thoughtfully crafted spaces that exude timeless elegance and comfort

At Arcon Exotica, every apartment is a statement of style and sophistication. The combination of aesthetic design, functional layout, and luxurious amenities makes it one of the most desirable luxury apartments in Trivandrum.

Discover the joy of refined living in a home that inspires peace and fulfillment. Book your visit to Arcon Exotica today and explore why Arcon Homes remains a trusted name among top builders in Trivandrum.

Structure
  • RCC framed structure complying with seismic zone 3 designs and as per the structural design. Concrete grade and steel grade be as per structural consultant’s advice.
Doors & Windows
  • Entrance door – Teak Veneered Panelled Door with flush shutters
  •  Internal doors – Hardwood door frame and flush door shutter.
  • Toilet doors – Engineered door frame with water resistant moulded shutter.
  •  Hardware – All hardware will be in C.P/Brass.
  • Lock – Main Door &Bed Room door Locks will be mortise of
    Godrej/Dorset/Ozone/Sifon makes and Toilet Doors will
    have “dead” latch of Hafele/Ozone/Sifon
  •  All regular windows, ventilators and balcony sliding doors will be powder coated aluminium with 5mm glass
Electrical
  • Concealed copper wiring shall be done for lighting, fans, power points, AC points using RR cable/HavellsStandard/Havells /Poly cab
  • Wired provision for the water heater point and exhaust fan point shall be provided for all the apartment toilets
  • Wired provision for telephone and internet point shall be provided in the living room & master bed room.
  • Provision for cable TV/DTH in the living room & master bed room.
  • Switches: Modular plate switches shall be provided Legrand (Lincus)/Schneider(Livia)/Havells(Fabio)
  • Adequate ELCB and MCB shall be provided in each apartment using Legrand/Schneider/Havells.
  • DG Power Back up : Power back up will be provided for all common service and selected light and fan points in living, bed rooms ,TV points and a refrigerator point shall be provided .power back up to maximum 600W for each apartment. (AC point, water heater point and other16Ams point will not be considered for the power back up)
  • Light Fixtures: For Common areas, Garden areas and at the top of Main entrance door of individual apartments
Sanitary & Plumbing
  • Master Bed Room Toilet – Wall-hung EWC with concealed flush tanks. Vanity Counter and Wash bowls. All sanitary fittings shall be of CERA/JAQUAR/ KEROVIT
  • Other Bedroom Toilet – Wall hung EWC with concealed flush tanks, wall hung wash basin. All sanitary fittings shall be of CERA/JAQUAR/KEROVIT
  • Concealed Cistern (Concealed flushing system)– will be of GEBRIT/CERA/JAQUAR
  • CP fittings of all toilets – single lever concealed diverter for shower and spout. Pillar tap shall be provided for washbasin, health faucet with angle valve shall be provided in all bathrooms. All fittings shall be of CERA/JAQUAR/KEROVIT.
  • Hot Water- Provision for hot water will be provided for all apartments’ overhead shower and spout only.
  • Pipes: All supply lines will be with ISI marked CPVC/PVC pipes.
  • Kitchen & Work Area: Wall mounted Faucets taps using JAGUAR/CERA/KEROVIT brand.
  • Kitchen Sink-Stainless Steel sink single bowl with drain board of ISI make for Kitchen, and stainless sink without drain board will be provided for the work area shall be of Prince/Metro.
  • Accessories- Accessories like Towel rods, Soap Dish with C.P. finish will be provided inside the toilets. Towel ring shall be provided near dining washbasin
Flooring & Tiling + Railing
  • Lift lobby and fascia using composite marble/granite/vitrified tile as per the architects design.
  •  Staircase using vitrified tile and hand railing using MS / G.I sections as per architects design.
  • Car park Area: For Basement floor seamless VDF flooring with groove/exterior grade paving tile as per the architects design in specific areas. For Ground floor and First floor finished with cement mortar screeding with groove.
  •  Foyer/Living/Dining/Bed Rooms/Kitchen using 80cm x 80cm or 60cmx120cm vitrified tiles of CERA/KAJARIA/JOHNSON/QTONE/SOMANY/KERAMICA as per architects design.
  •  Toilets: Ceramic tile for floor and for walls up to door height as per architects design of CERA/KAJARIA/JOHNSON/SOMANY/KERAMICA/GRES GRANITO
  •  Balconies: Rustic or antiskid ceramic tiles and G.I railings as per architects design up to 1.20M minimum height.
Painting
  • Regular wall Emulsion paint with putty finish using Asian / Berger / Nerolac in all apartments and in the common areas and utility services areas.
  • Regular ceiling emulsion paint Asian/ Berger / Nerolac for the ceiling inside apartments & common areas.
  • External Walls: Weather proof/exterior grade emulsion using Asian / Berger / Nerolac
Elevators
  • Elevators – 2 Nos. will be provided with automatic doors of OTIS / JHONSON / THYSSENKRUP / FUJITEC / ESCON
Air Conditioning
  • Wired provision for installing split Air-conditioners will be provided for all bed rooms.
Automation
  • Access control entry at main entrance lobby area.
  • Gas leakage cut out valves will be provided in each apartment.
Landscaping
  • Interlock Pavers to be laid in driveways
  • Entrance Gate as per architect design
Water & Electricity
  • Bore well water shall be provided through UG sump and overhead tank for drinking and non-drinking purposes.
  • Kerala Water Authority water connection can be made available at extra cost. The extra cost will include labour charges, material charges, deposits, tar cutting charges and all other relevant charges to take the connection from Kerala water Authority connection point to UG sump.
  • 3 Phase electricity shall be provided.

Amenities & Features

  • Roof top swimming pool with changeroom and lockers.

  • Kid's pool.

  • Landscaped roof top party area.

  • Fully equipped air - conditioned gym with 2 Nos Motorized tread mill, 1 o. Elliptical cross trainer, 2 Nos cycling machine and 1 No home gym.

  • Designer Entrance Lobby.

  • Air - conditioned guest suite.

  • Kidsplay area with play equipments.

  • Car parking for differently abled.

  • Two automatic elevators with rescue device.

  • Biometric access at main lobby area.

  • CCTV surveillance cameras in key areas.

  • Provision for Round the clock security.

  • Solar powered lights for lobby areas.

  • Generator back - up for common areas and designated points in the apartment.

  • DTH / cable provision in living and master bedroom.

  • Intercom facility between apartments and the security cabin.

  • ewage treatment plant or provision for drainage connection.

  • Bio bins for solid waste management.

  • Provision for Wi-Fi internet.

  • Individual letter boxes.

  • Shopping trolleys.

  • Owners name board.

  • Reticulated gas supply.

  • Association Room.

  • Multipurpose hall.

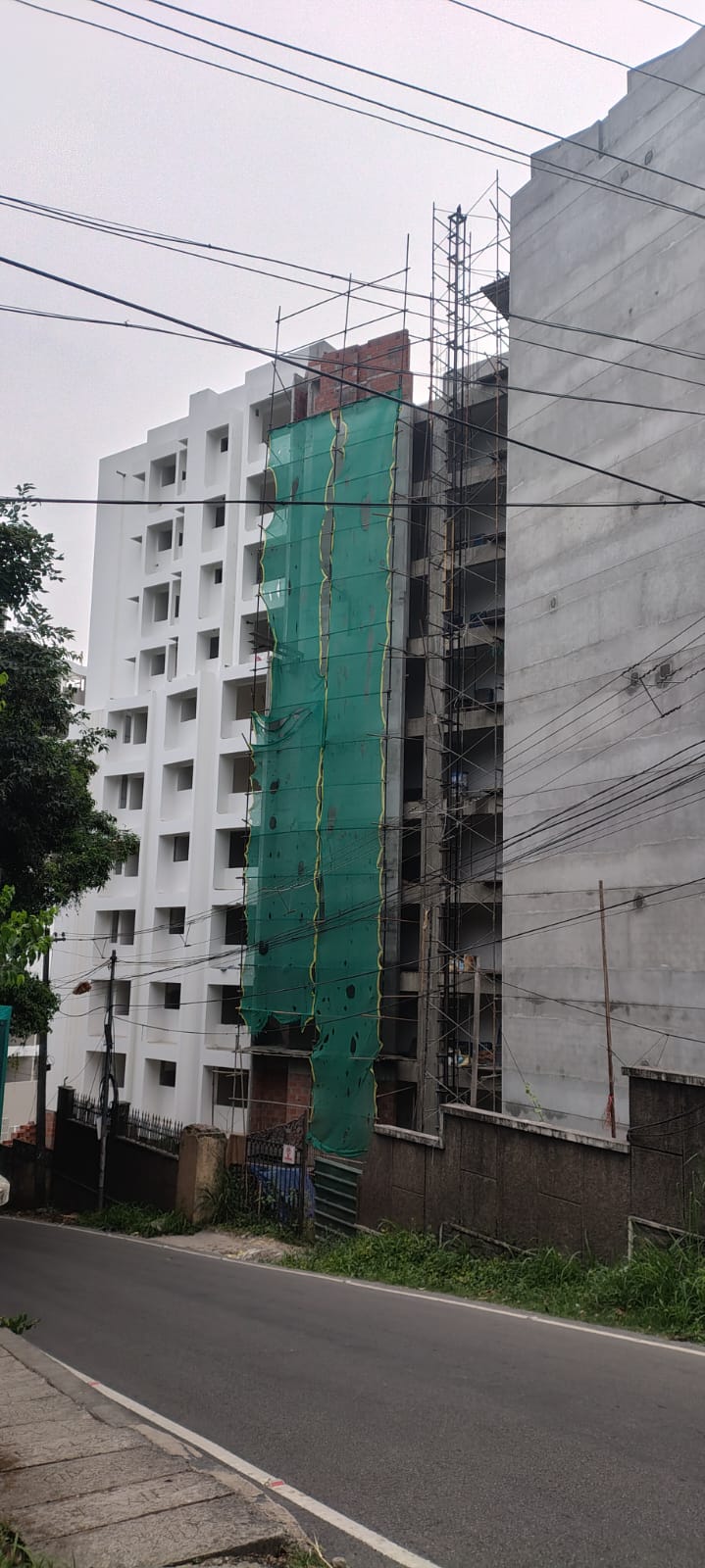

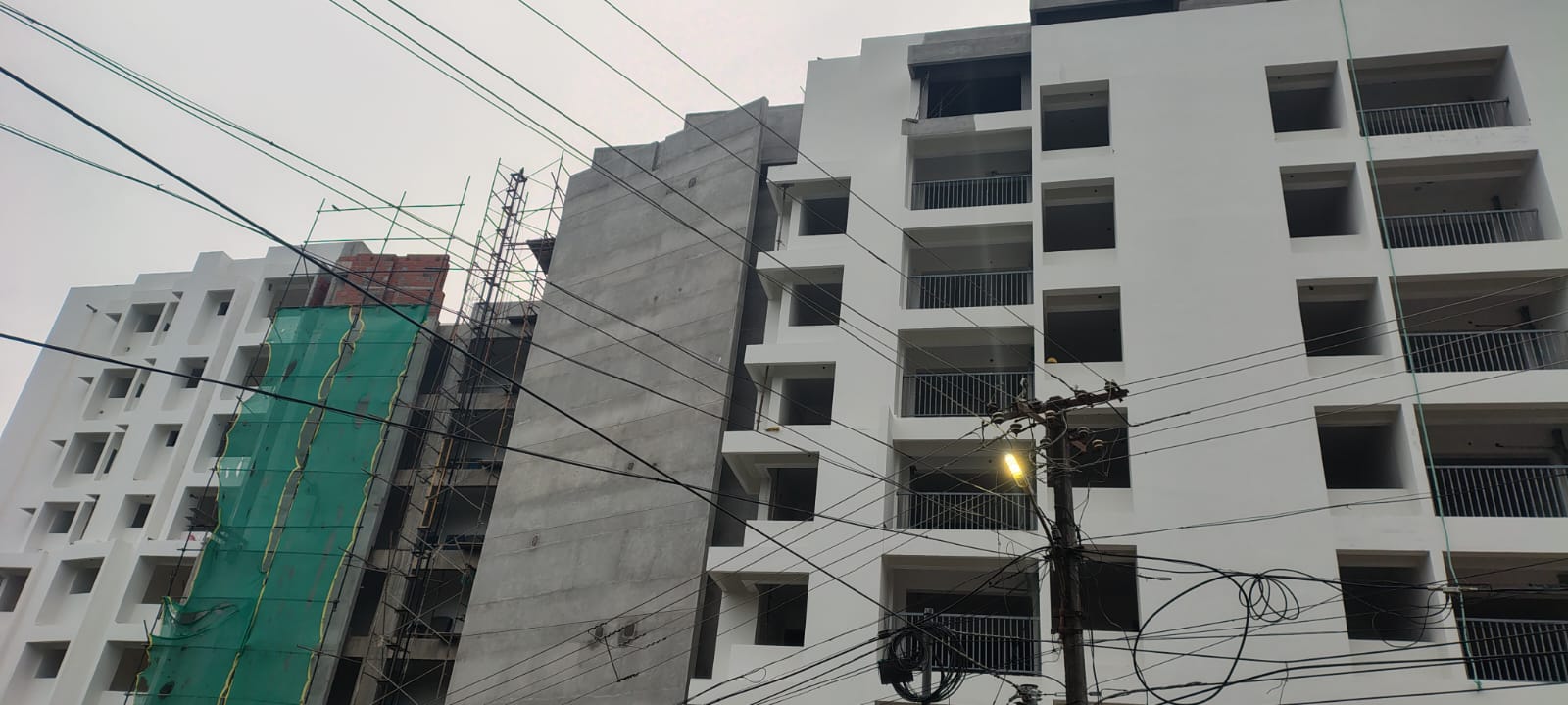

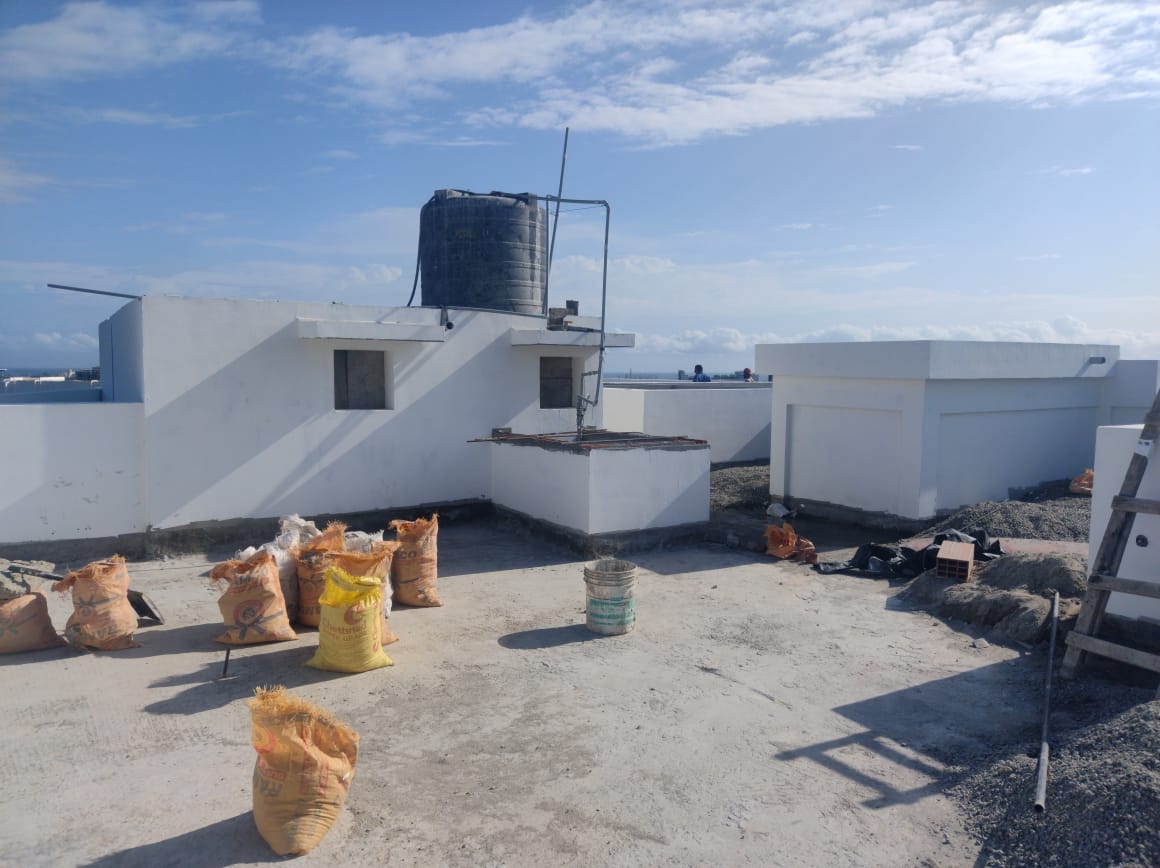

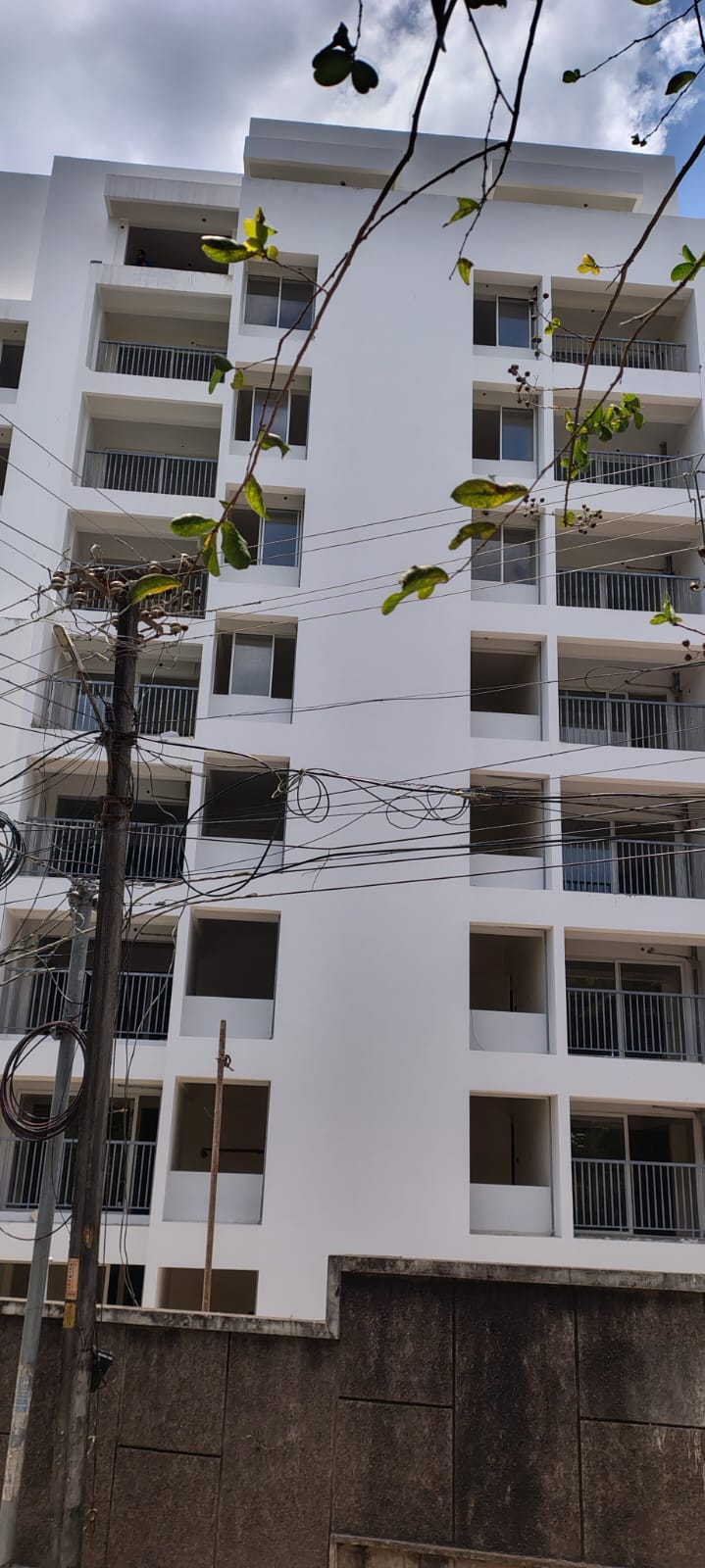

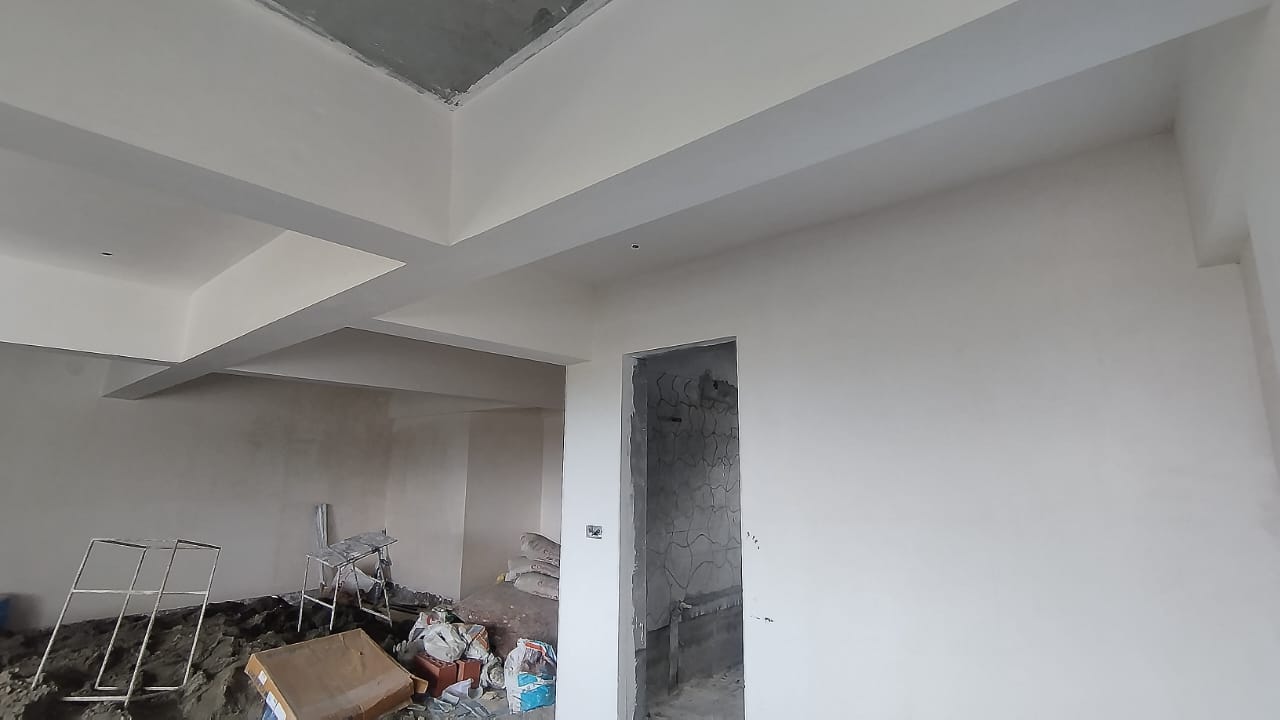

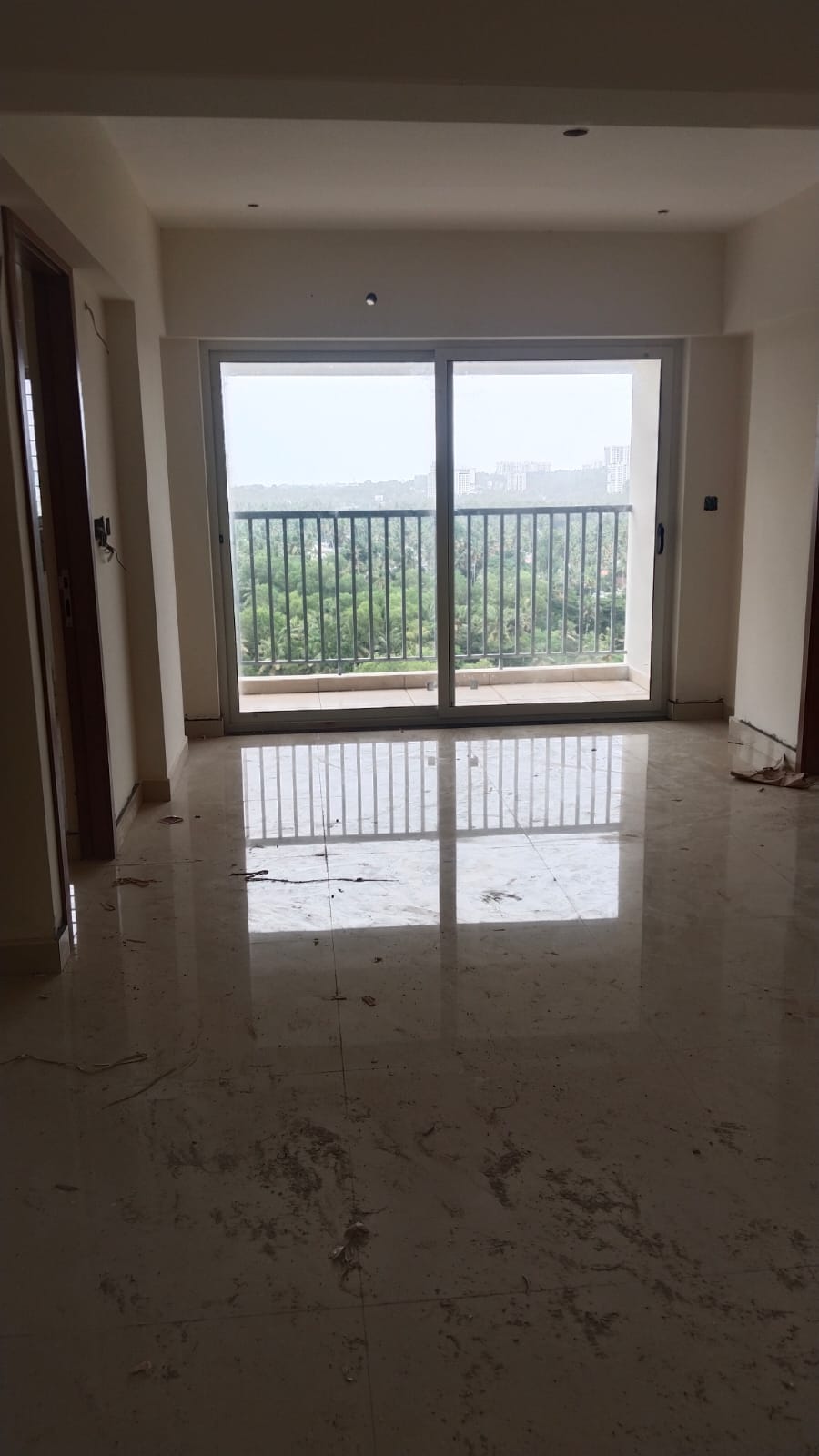

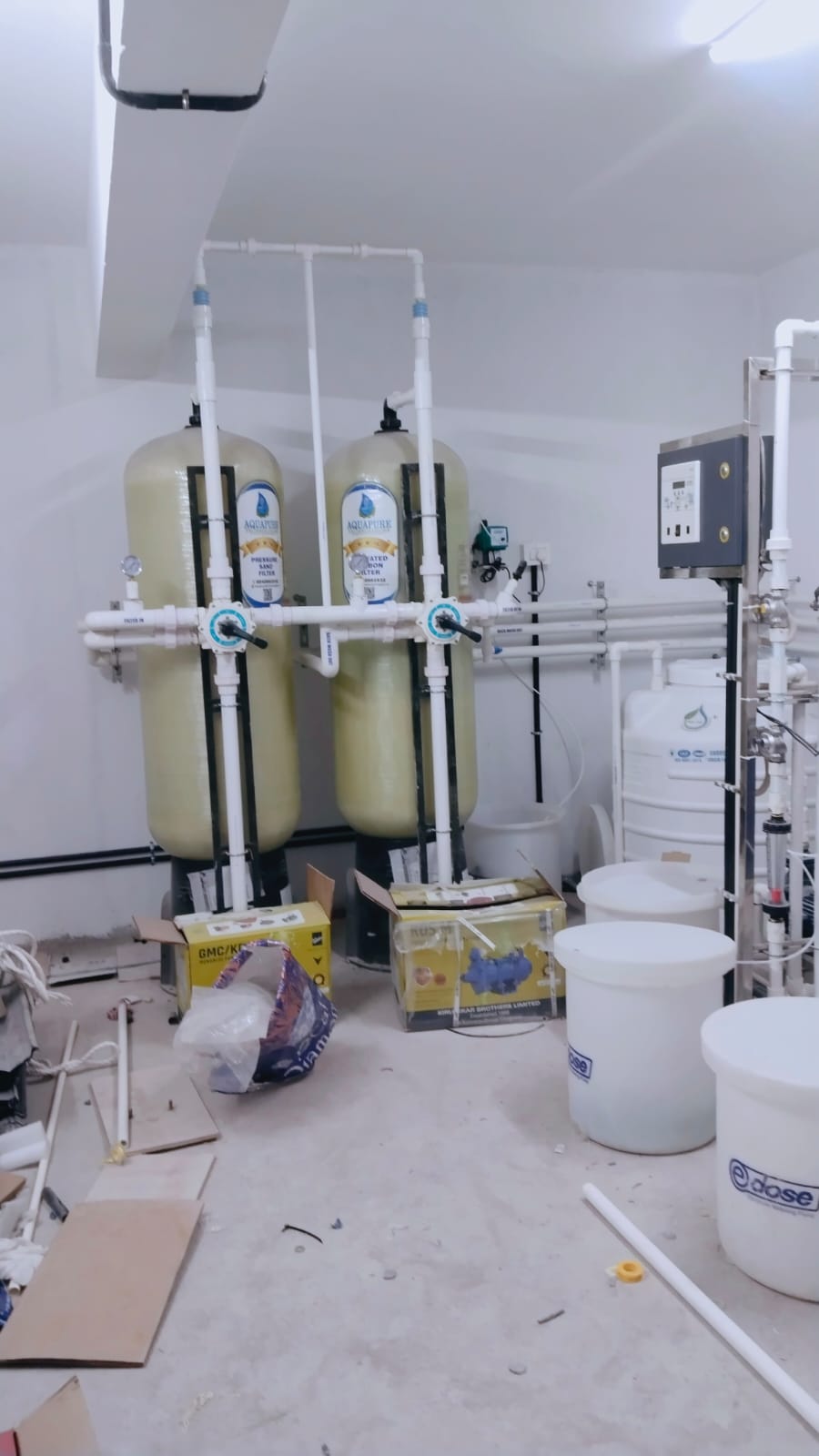

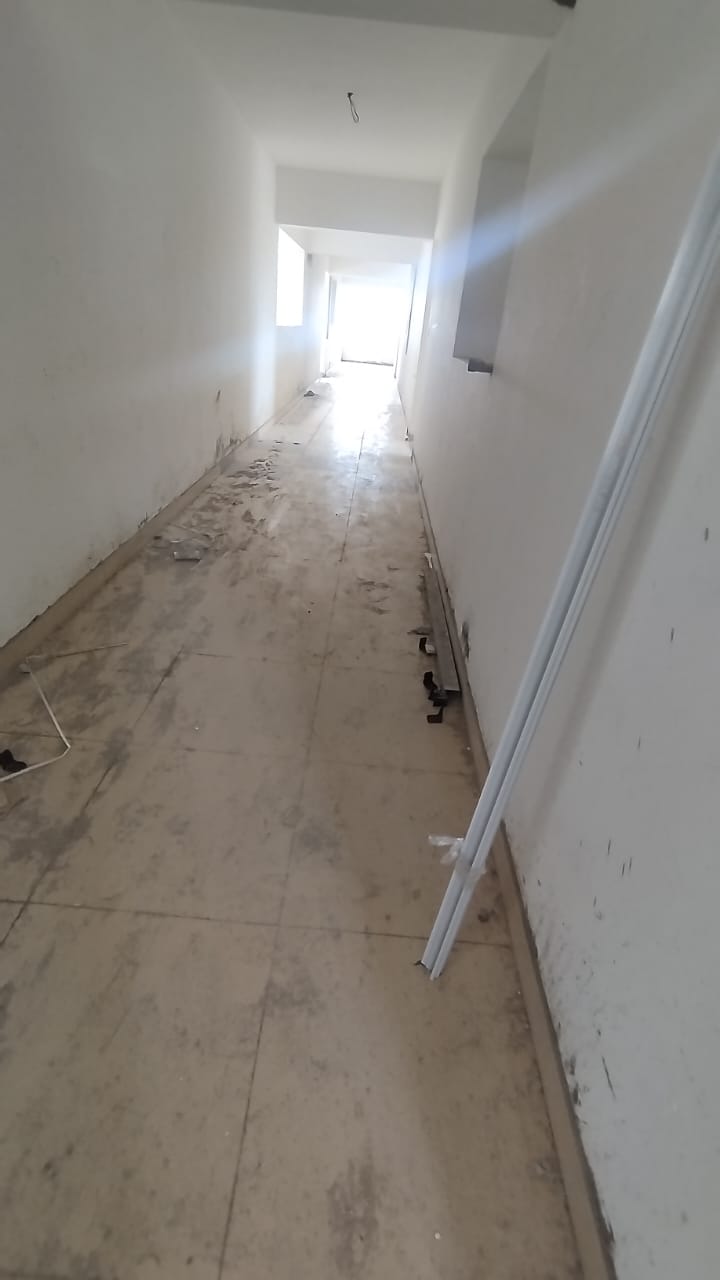

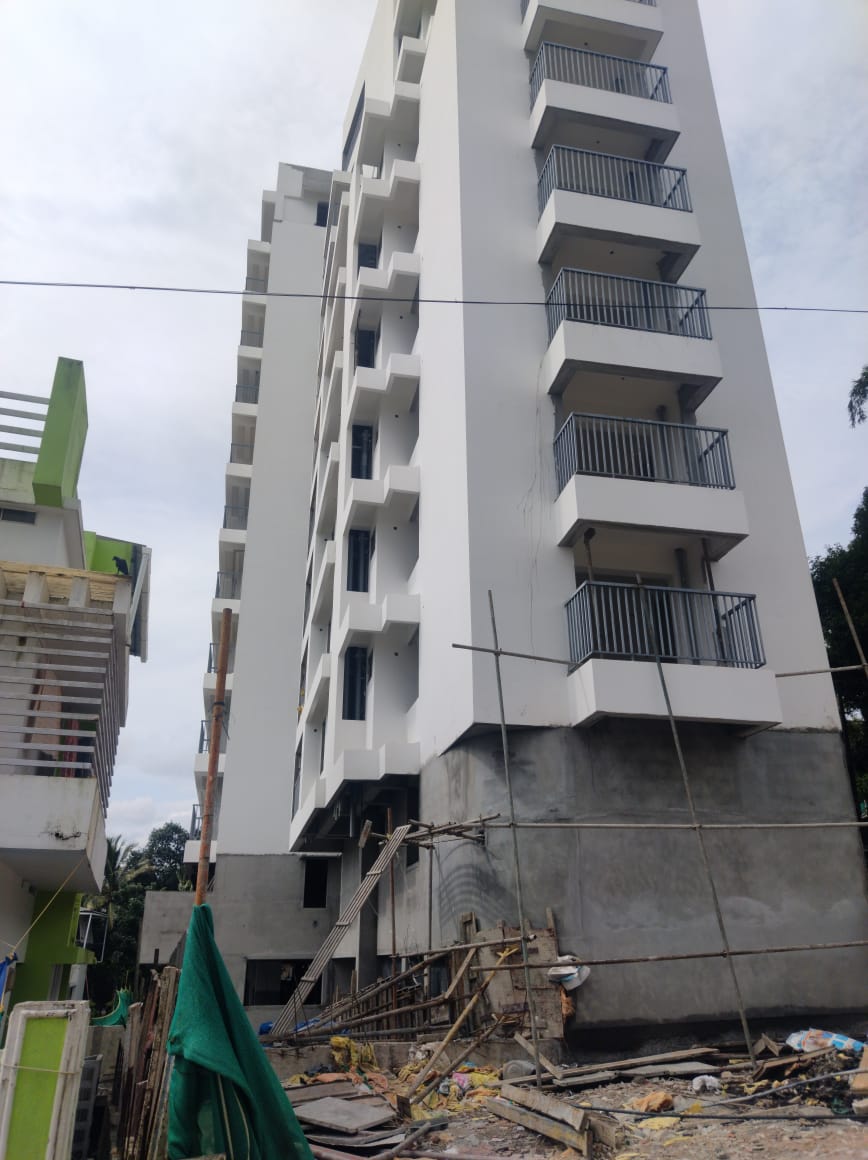

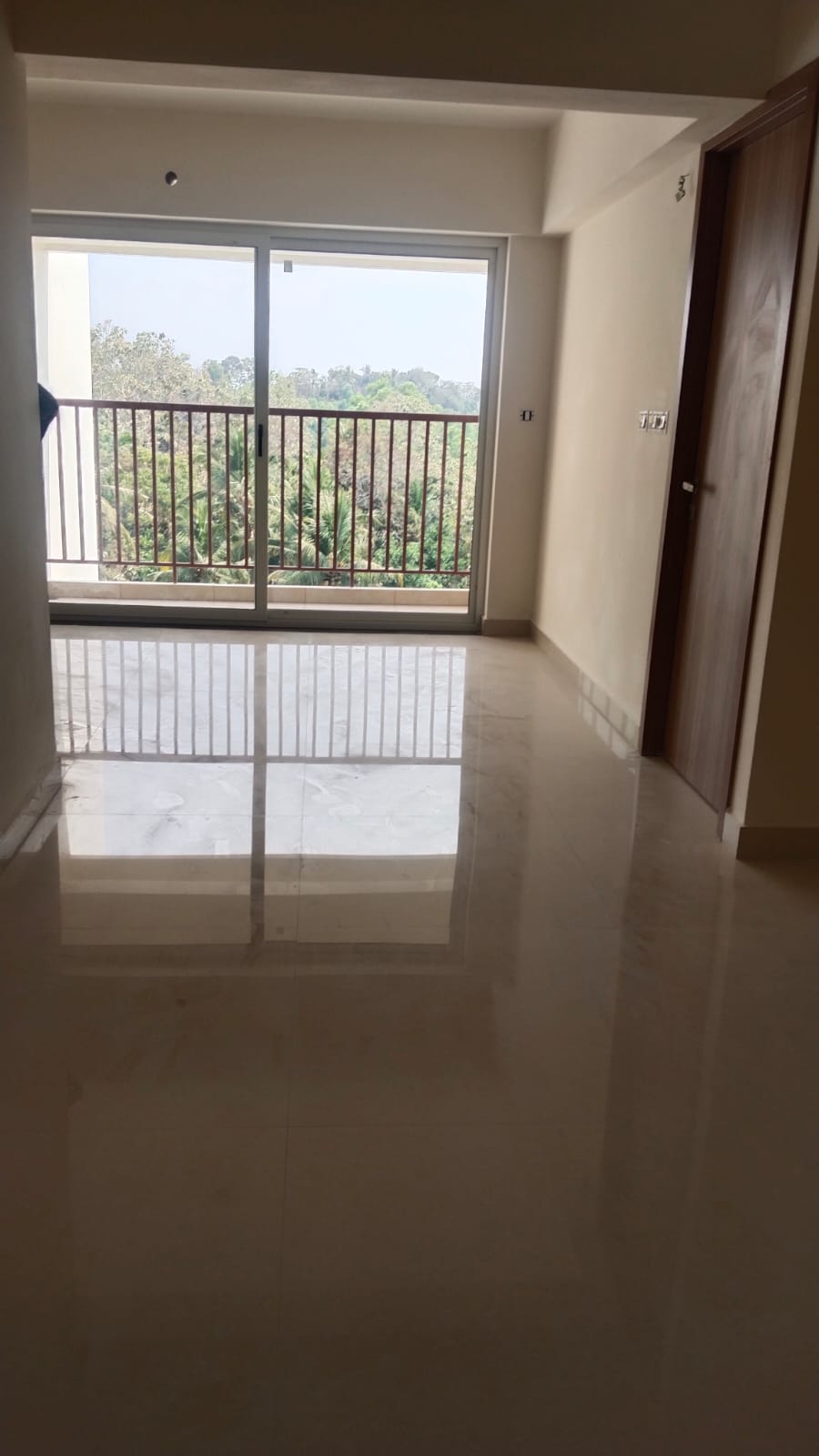

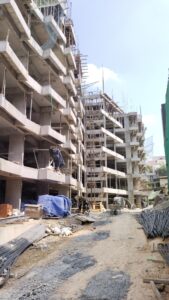

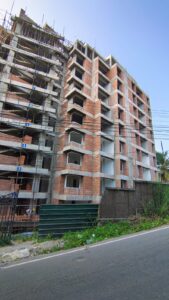

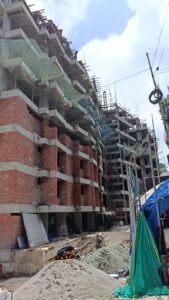

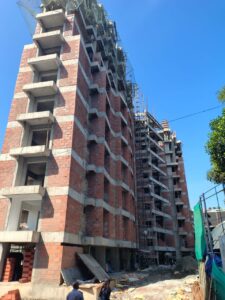

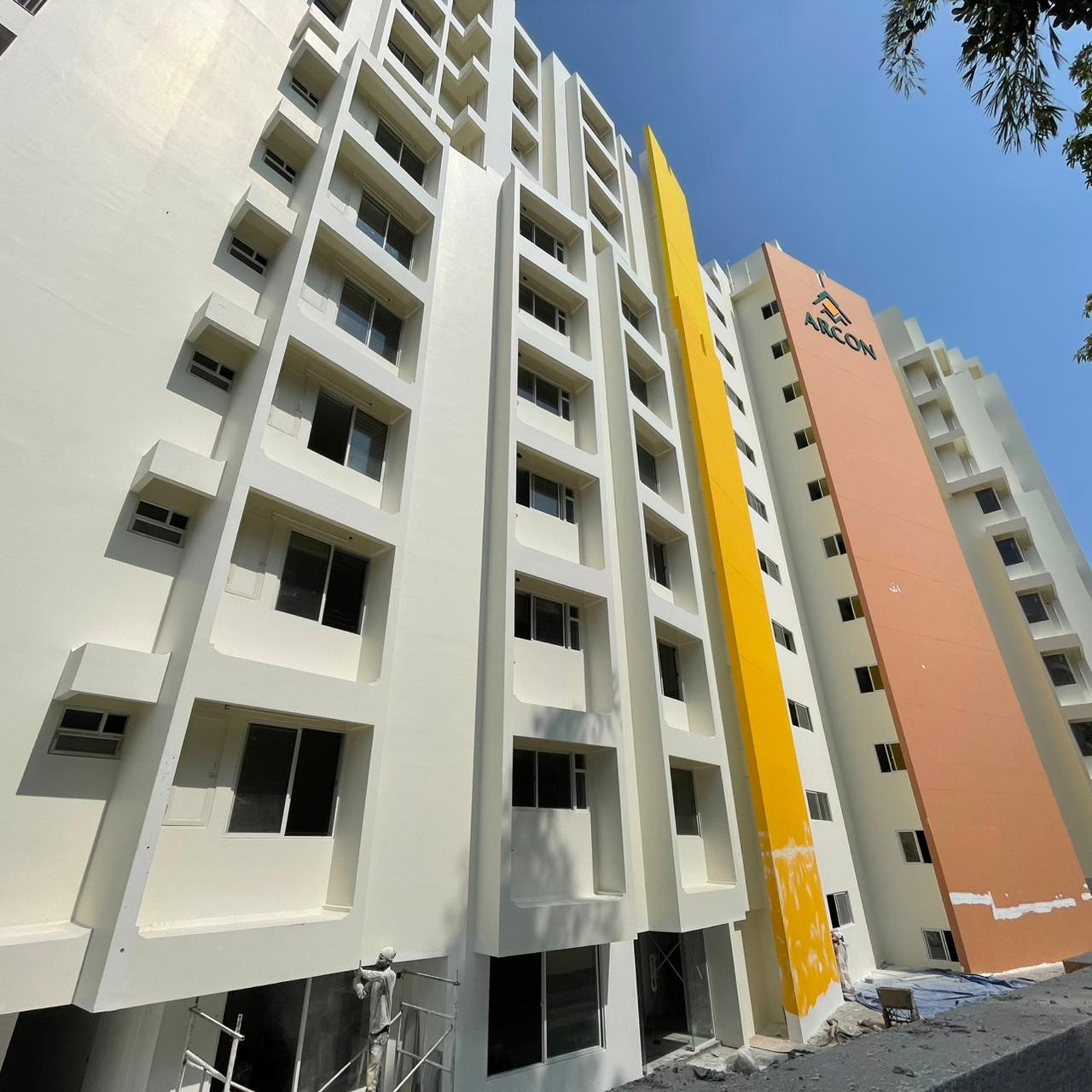

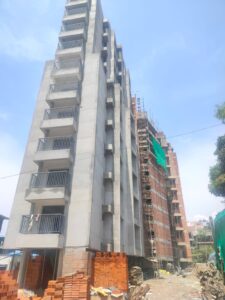

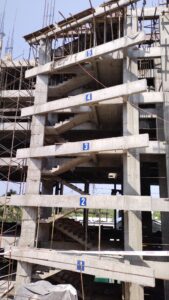

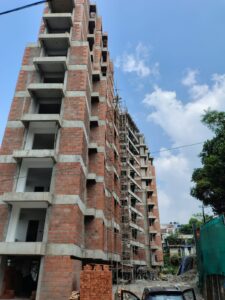

07-02-2026

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%,Duplex roof – 100%

WALL Plastering

First Floor to 9th floor- 100%,

Pent House-100%

Outside wall plastering-complete

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing 1st floor- 10th floor-100%

Plumbing Work

1st to 10th floor plumbing work – 100%,

Waterproofing Work

1st to 10th floor waterproofing work – 100%

Painting Work

1st to 9th floor putty work – 100%,

1st floor painting-20%
1st coat painting-9th floor,5th floor-1st floor-100%

Outside putty work South side-100%
Outside putty work west side-100%
Outside putty work east side-100%
Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Ninth Floor – 100%

 Tenth Floor-99%

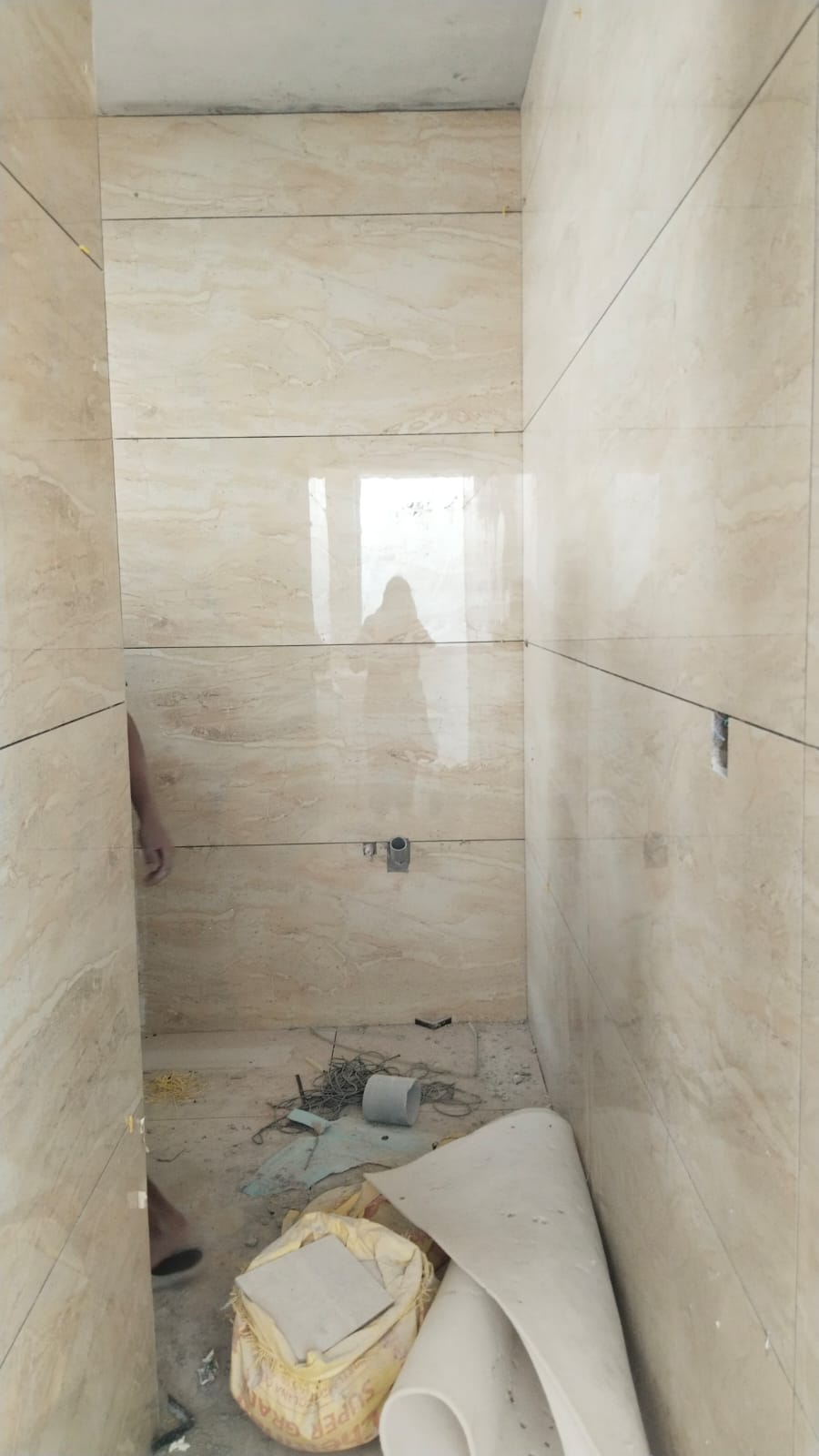

Tile Work

First Floor – 100%

9th floor-100%

8th floor-100%

7th floor-100%

6th floor-100%

5th  floor-84%

4th  floor-84%

3rd  floor-100%

2nd  floor-100%

Terrace floor-100%

Core cutting Work

First -10h Floor – 100%

Aluminium fabrication Work  APARTMENTS-100%

Window grill fixing-95%

Wood work

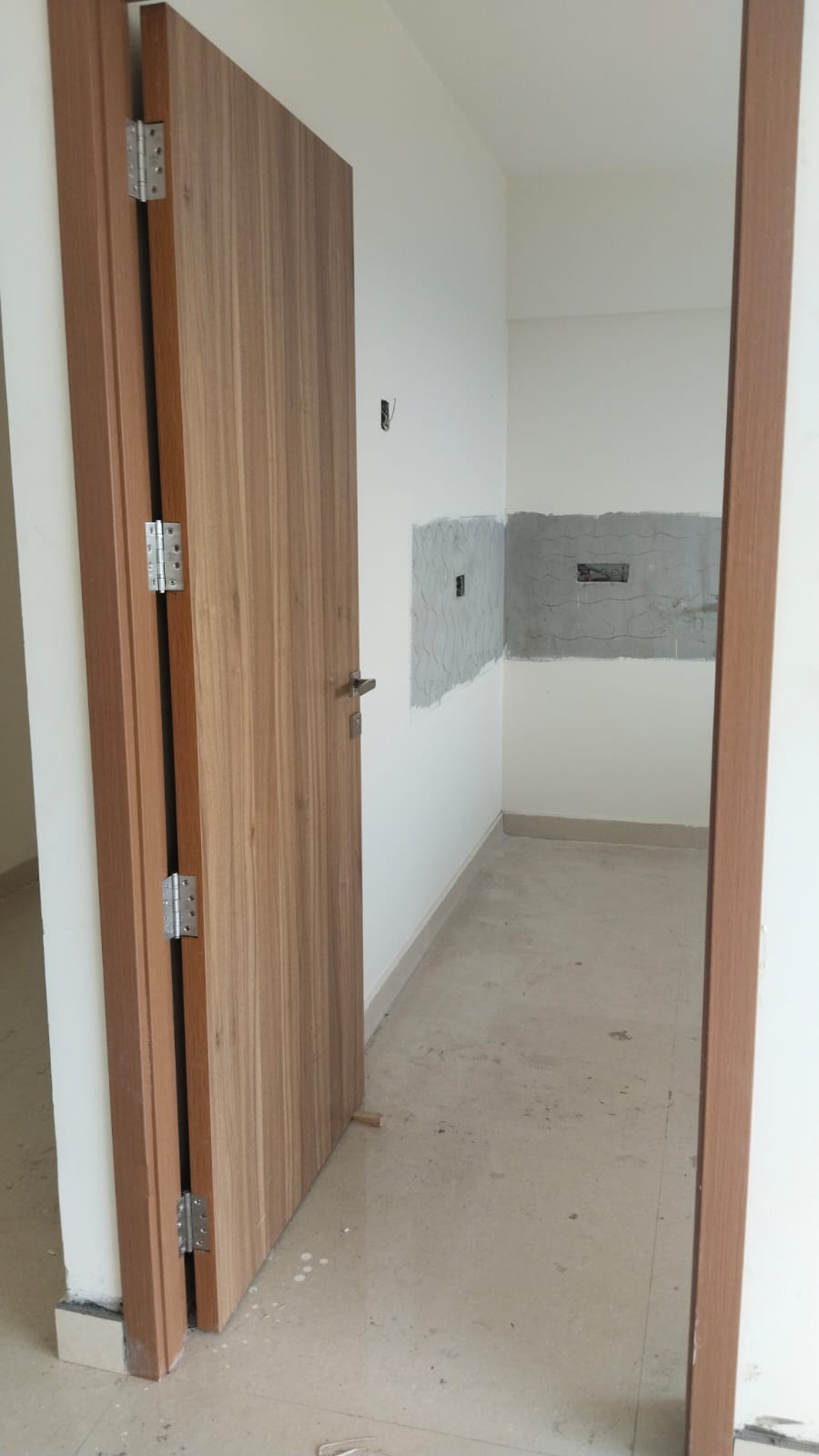

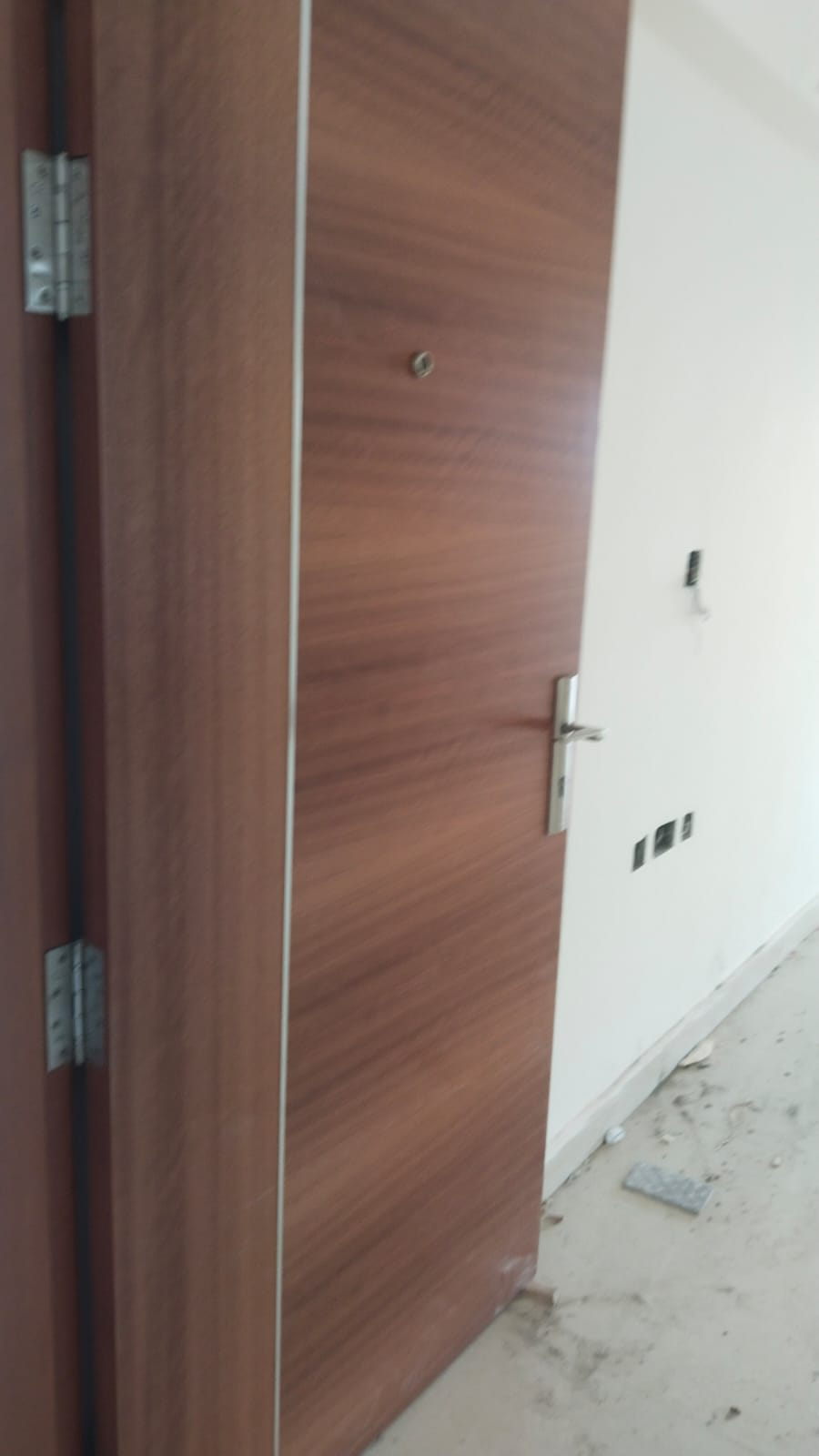

door fixing-90%

Balcony Handrail-100%

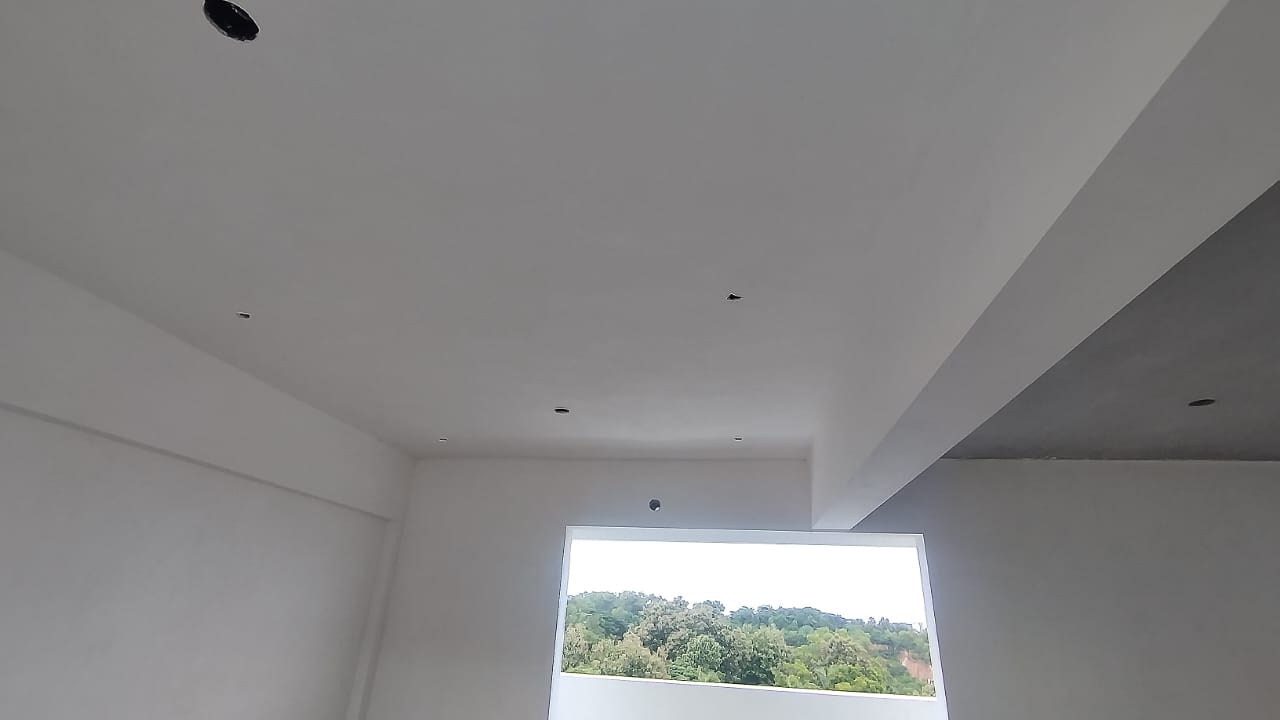

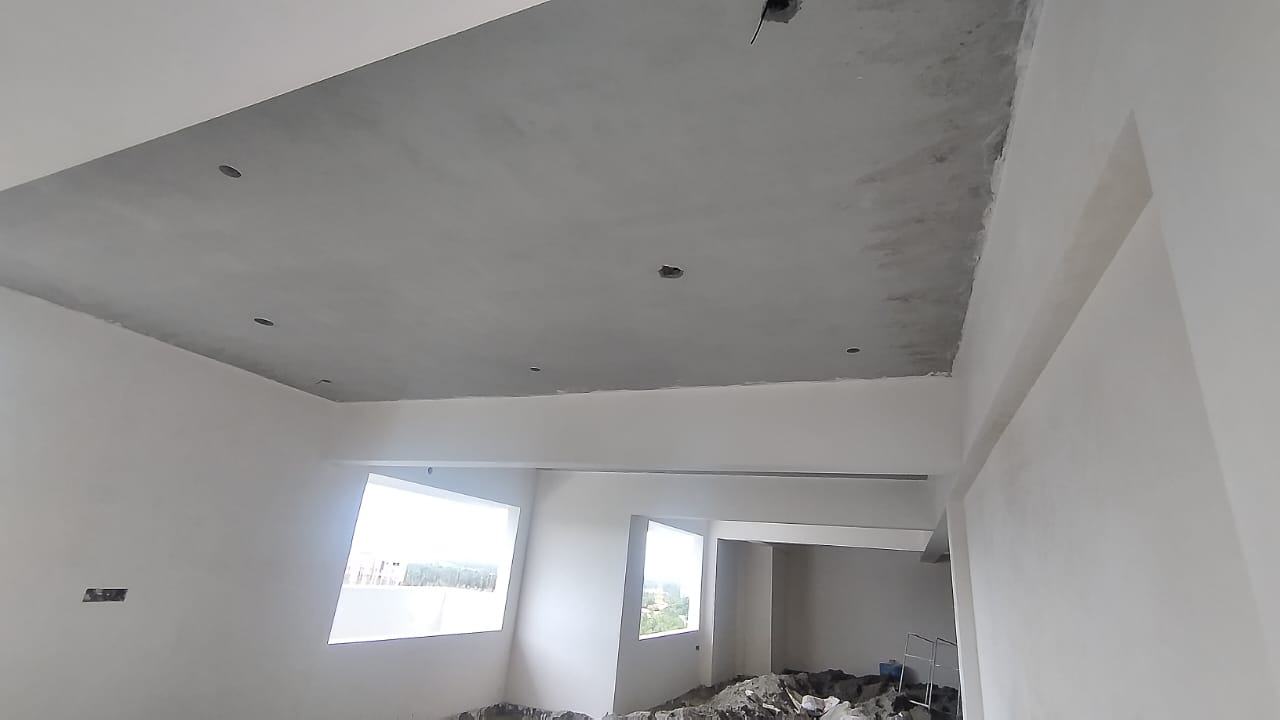

False Ceiling work-100%

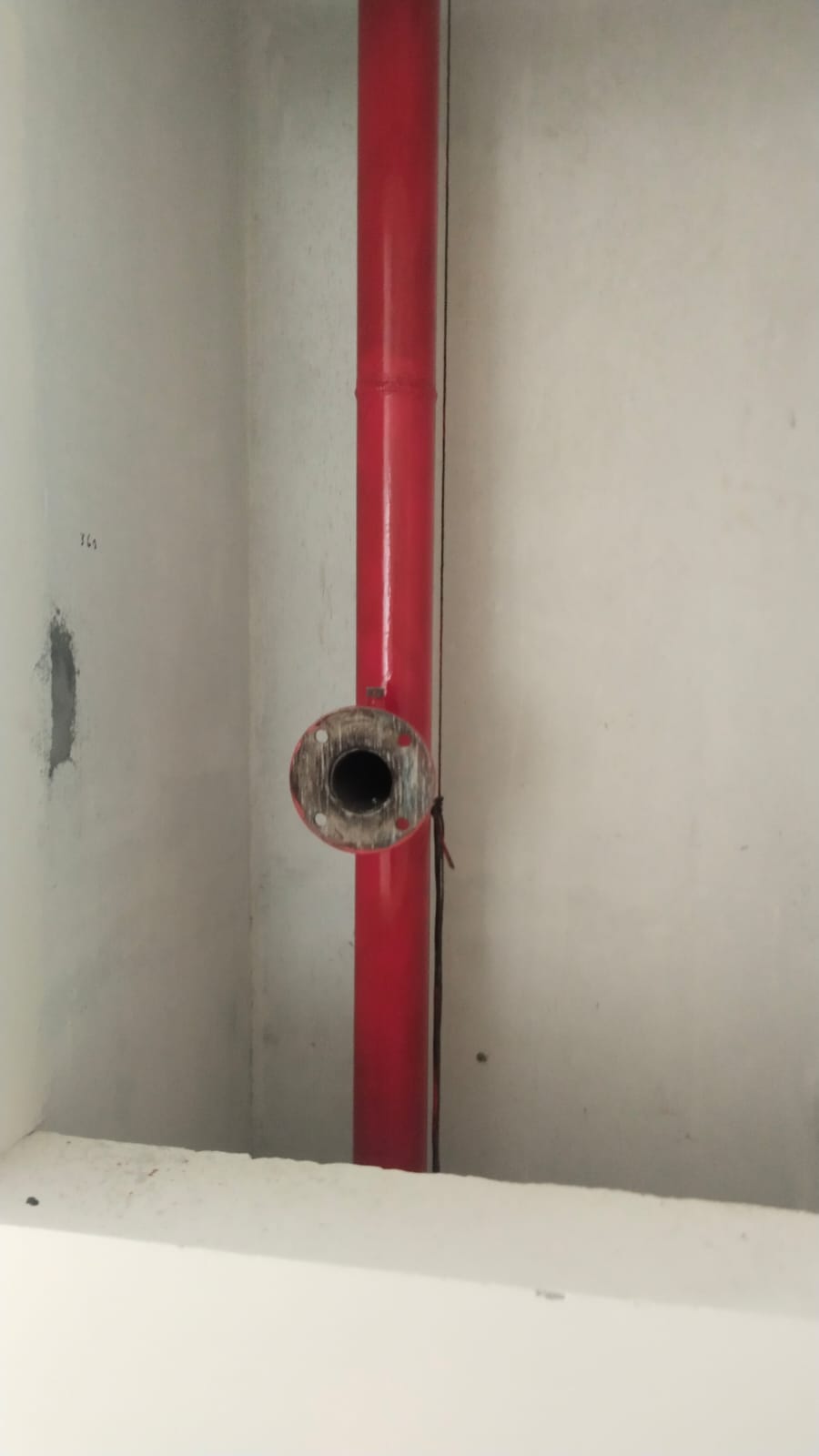

Fire line work-99%

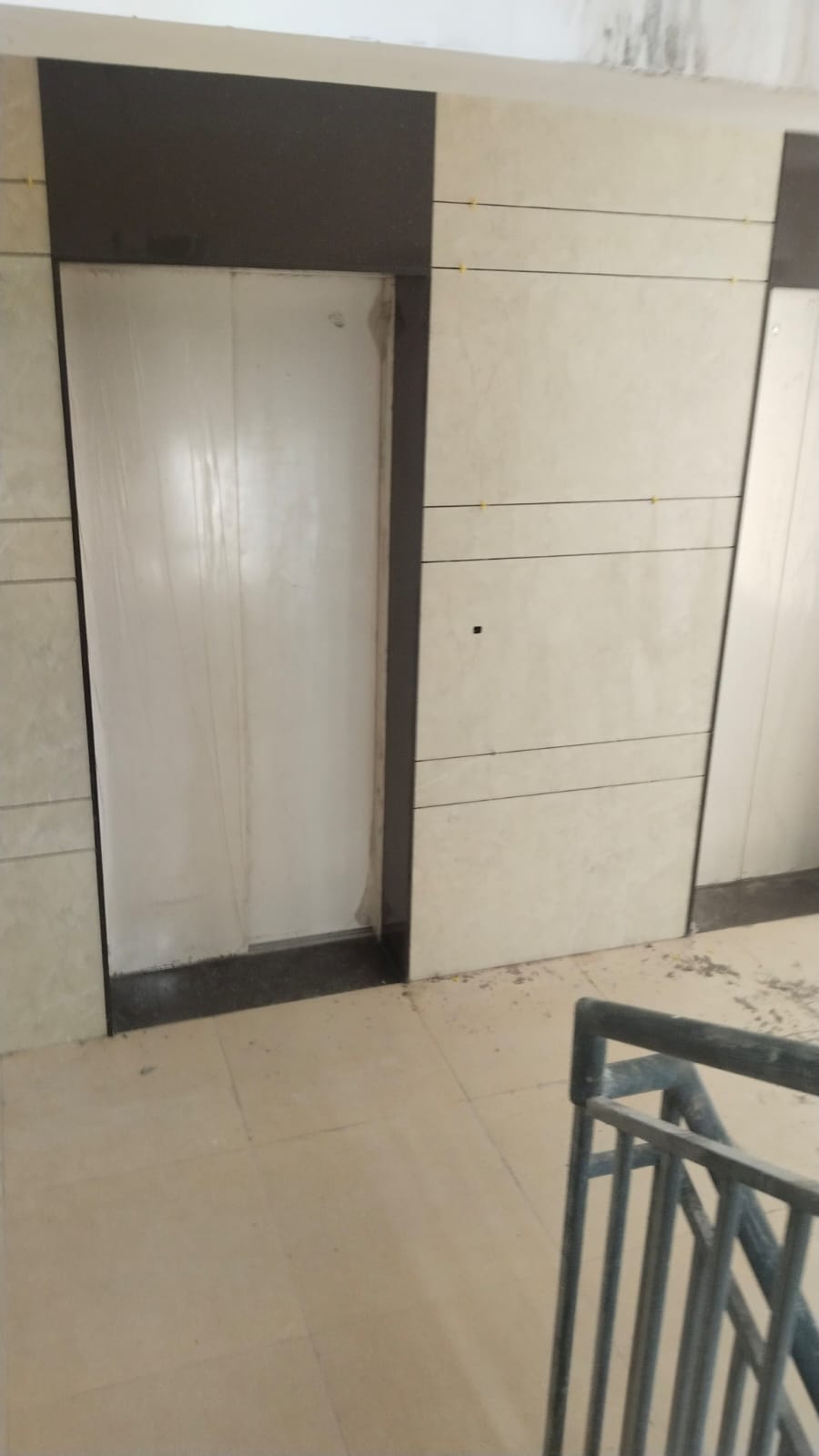

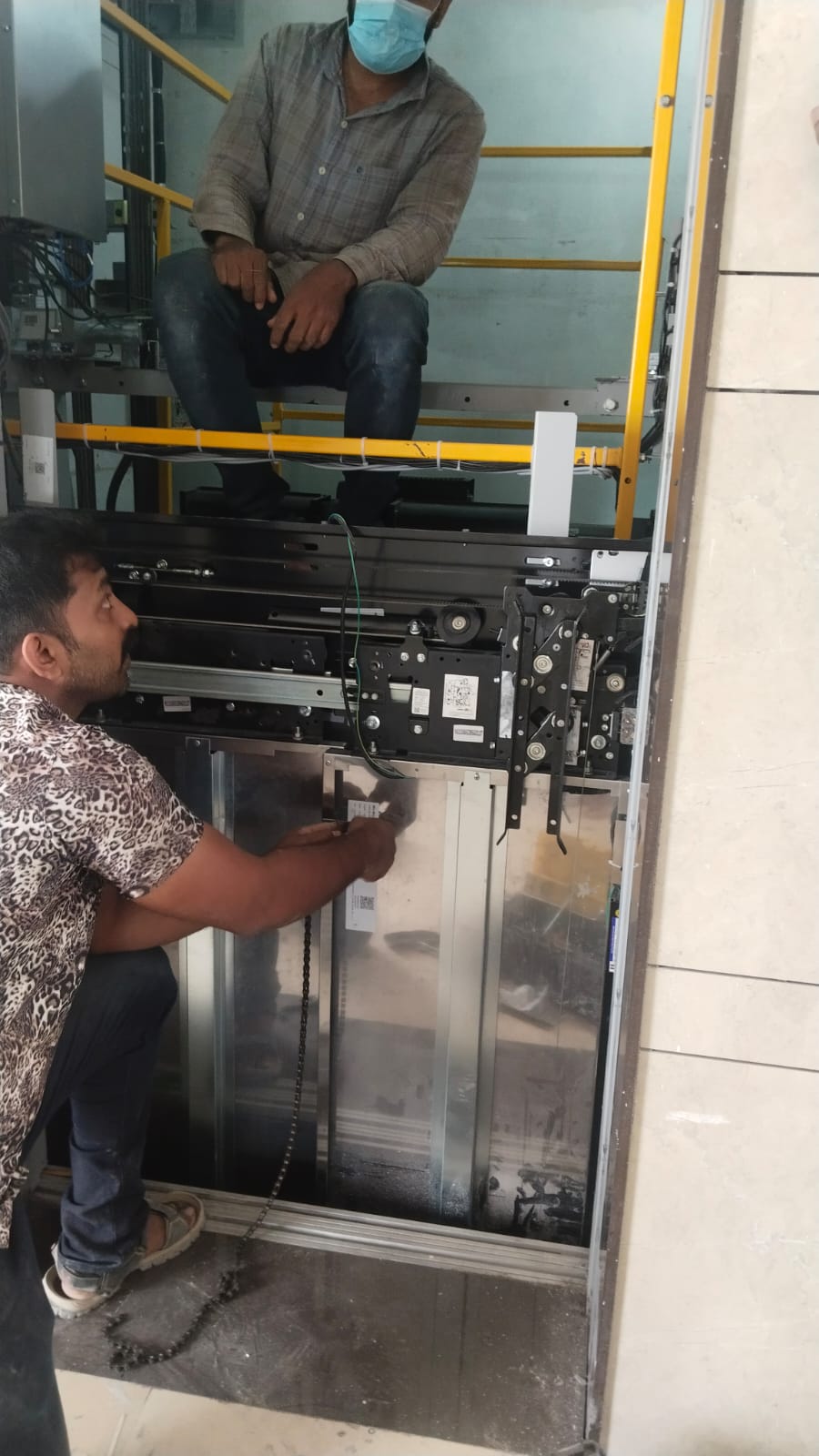

Lift door fixing and motor fixing work-100%
Gas line work-99%

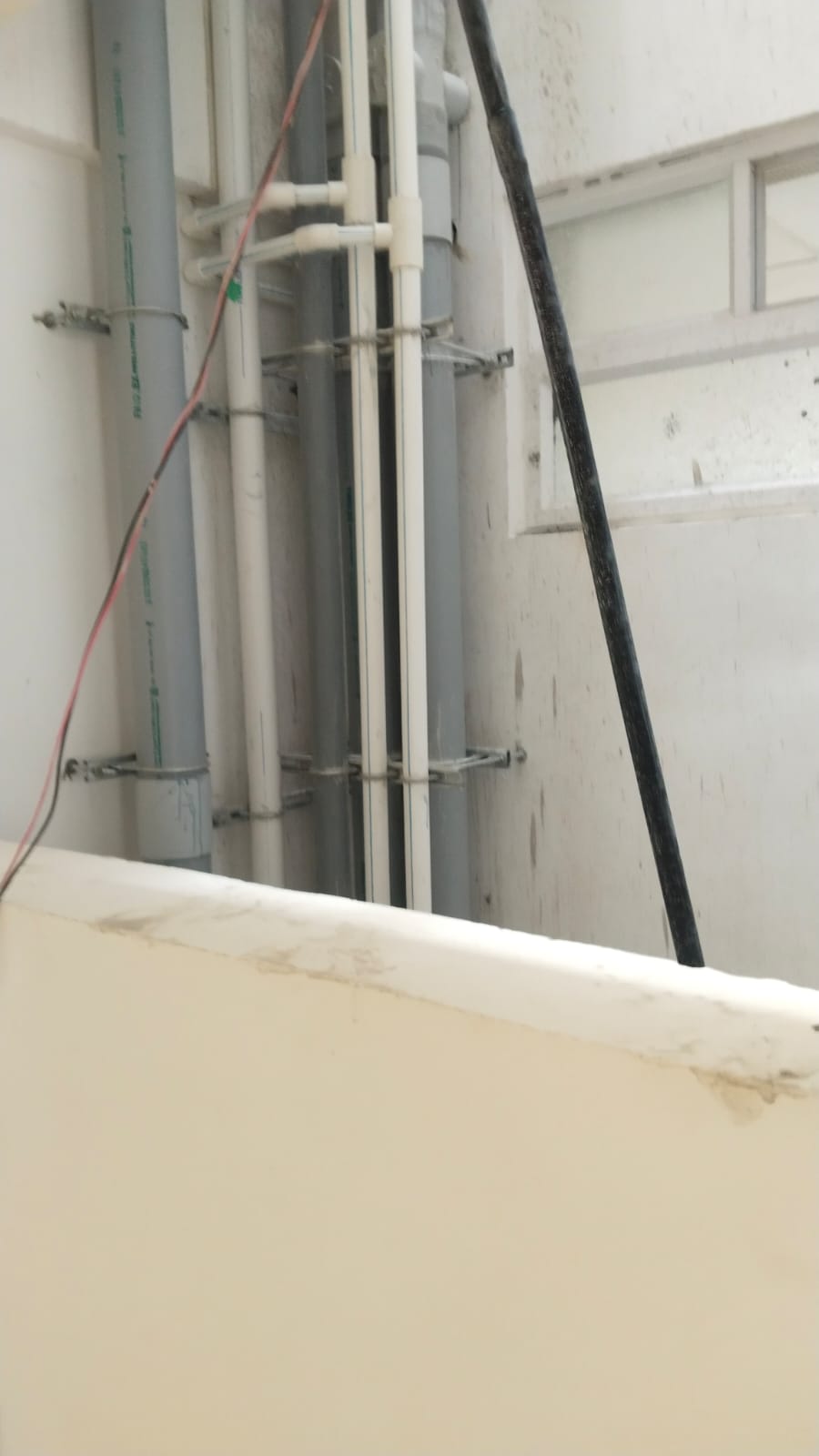

Ring line work-98%
STP Work-100%
Yard levelling-95%

SWITCH FIXING-85%

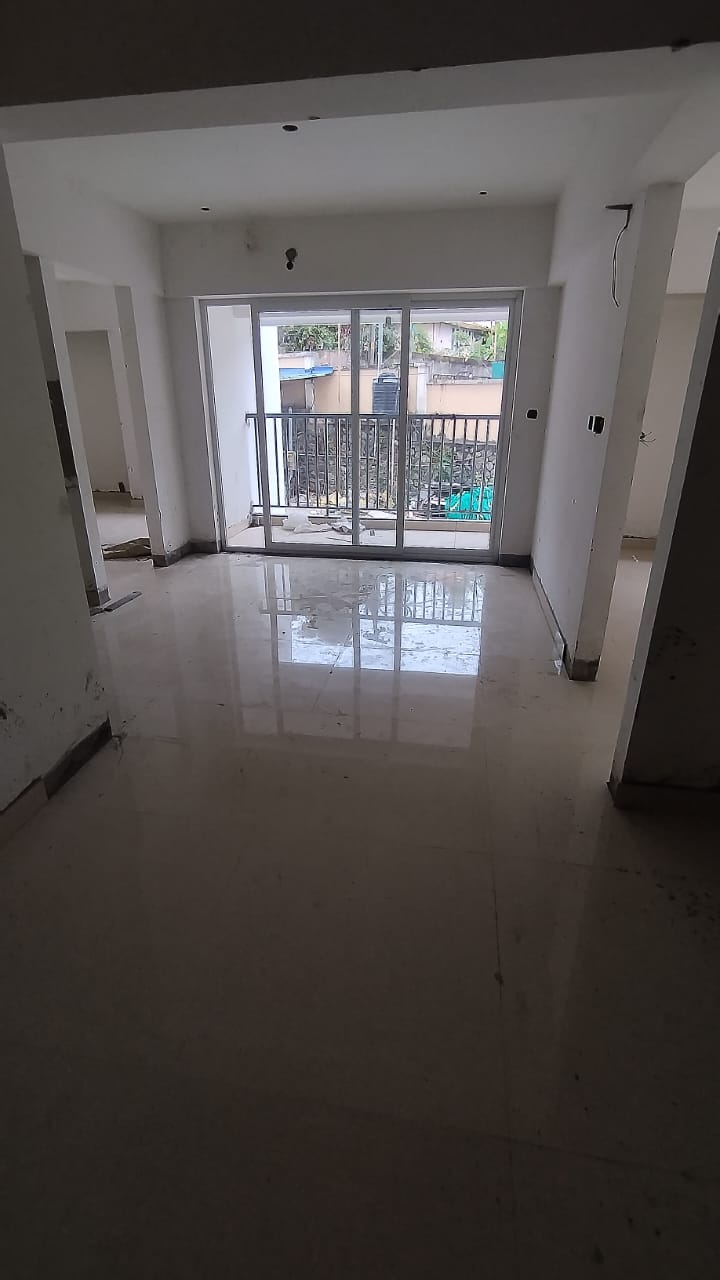

VDF WORK-100%
WTP WORK-100%
YARD TILING-50%
CAR PARKING AREA-75%
SANITARY FIXING-10%
KIDS PLAY AREA WORK-50%

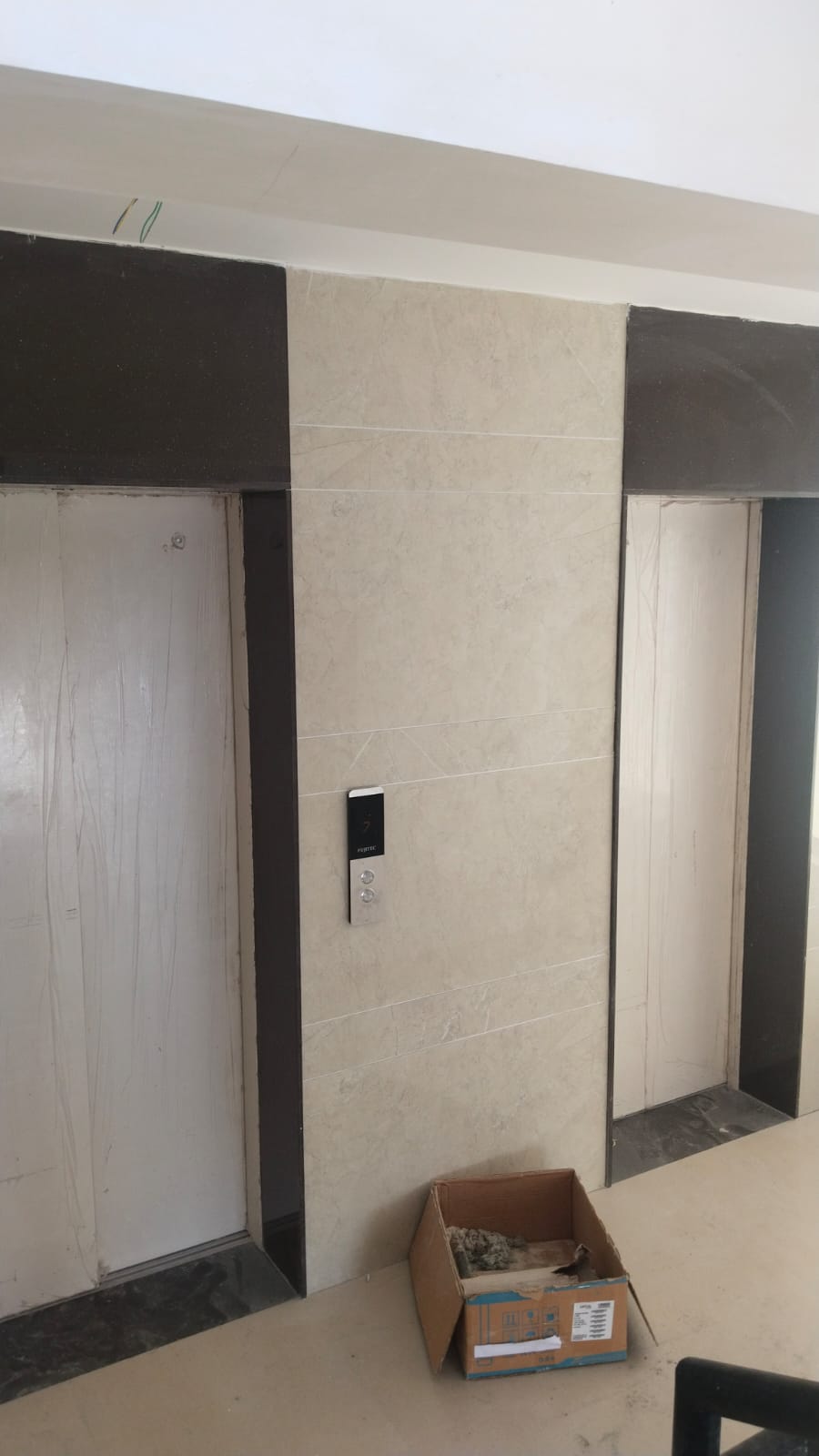

LIGHT FIXING INSIDE LOBBY-10%

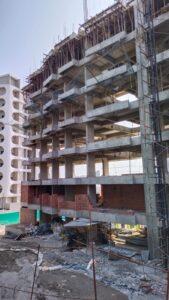

03-01-2026

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%,Duplex roof – 100%

WALL Plastering

First Floor to 9th floor- 100%,

Penthouse-100%

Outside wall plastering-complete

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing 1st floor- 10th floor-100%

Plumbing Work

1st to 10th floor plumbing work – 100%,

Waterproofing Work

1st to 10th floor waterproofing work – 100%

Painting Work

1st to 9th floor putty work – 100%,

1st floor painting-20%
1st coat painting-9th floor,5th floor-1st floor-100%

Outside putty work South side-100%
Outside putty work west side-100%
Outside putty work east side-100%
Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Ninth Floor – 100%

 Tenth Floor-99%

Tile Work

First Floor – 100%

9th floor-100%

8th floor-100%

7th floor-100%

6th floor-100%

5th  floor-84%
4th  floor-84%

3rd  floor-100%

2nd  floor-100%

Terrace floor-100%

Core cutting Work

First -10h Floor – 100%

Aluminium fabrication Work  APARTMENTS-100%

Window grill fixing-80%

Wood work
door fixing-90%

Balcony Handrail-100%

False Ceiling work-95%
Fire line work-99%
Lift door fixing and motor fixing work-100%
Gas line work-90%
Ring line work-90%
STP Work-100%
Yard levelling-95%
SWITCH FIXING-76%
VDF WORK-100%
WTP WORK-100%

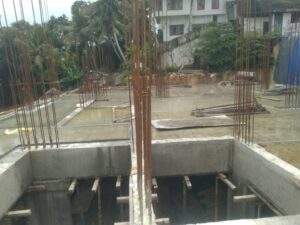

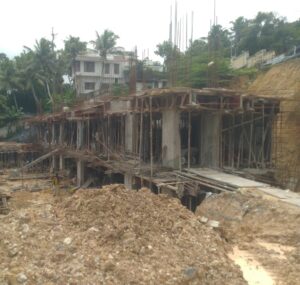

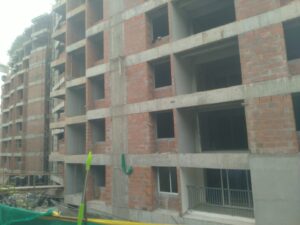

05-12-2025

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%,Duplex roof – 100%

WALL Plastering

First Floor to 9th floor- 100%,

Pent House-100%

Outside wall plastering-complete

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing 1st floor- 10th floor-100%

Plumbing Work

1st to 10th floor plumbing work – 100%,

Waterproofing Work

1st to 10th floor waterproofing work – 100%

Painting Work

1st to 9th floor putty work – 100%,

1st floor painting-20%
1st coat painting-9th floor,5th floor-1st floor-100%

Outside putty work South side-100%
Outside putty work west side-100%
Outside putty work east side-95%
Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Ninth Floor – 100%

 Tenth Floor-99%

Tile Work

First Floor – 100%

9th floor-100%

8th floor-100%

7th floor-100%

6th floor-100%

5th  floor-84%
4th  floor-84%

3rd  floor-100%

2nd  floor-100%

Terrace floor-100%

Core cutting Work

First -10h Floor – 100%

Aluminium fabrication Work  APARTMENTS-100%

Window grill fixing-52%

Wood work
door fixing-90%

Balcony Handrail-100%

False Ceiling work-95%

Fire line work-85%

Lift door fixing and motor fixing work-100%

Gas line work-70%

Ring line work-70%

STP Work-90%

Yard levelling-80%

SWITCH FIXING-60%

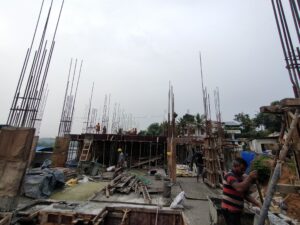

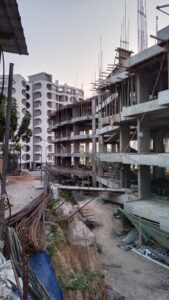

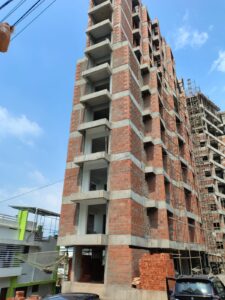

07-10-2025

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%,Duplex roof – 100%

WALL Plastering

First Floor to 9th floor- 100%,

Pent House-100%

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing 1st floor- 10th floor-100%

Plumbing Work

1st to 10th floor plumbing work – 100%,

Waterproofing Work

1st to 10th floor waterproofing work – 100%

Painting Work

1st to 9th floor putty work – 100%,

1st floor painting-20%
1st coat painting-9th floor,5th floor-1st floor-100%

Outside putty work-95%

Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Ninth Floor – 100%

 Tenth Floor-99%

Tile Work

First Floor – 100%

9th floor-100%

8th floor-100%

7th floor-100%

6th floor-100%

5th  floor-84%
4th  floor-84%

3rd  floor-100%

2nd  floor-100%

Core cutting Work

First -10h Floor – 100%

Aluminium fabrication Work-60%

Wood work
door fixing-50%

Balcony Handrail-100%

False Ceiling work-95%
Fire line work-50%
Lift door fixing and motor fixing work-100%
Gas line work-50%
Ring line work-50%

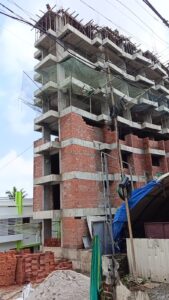

05-08-2025

Piling work – 100%

Pile cap work – 100%

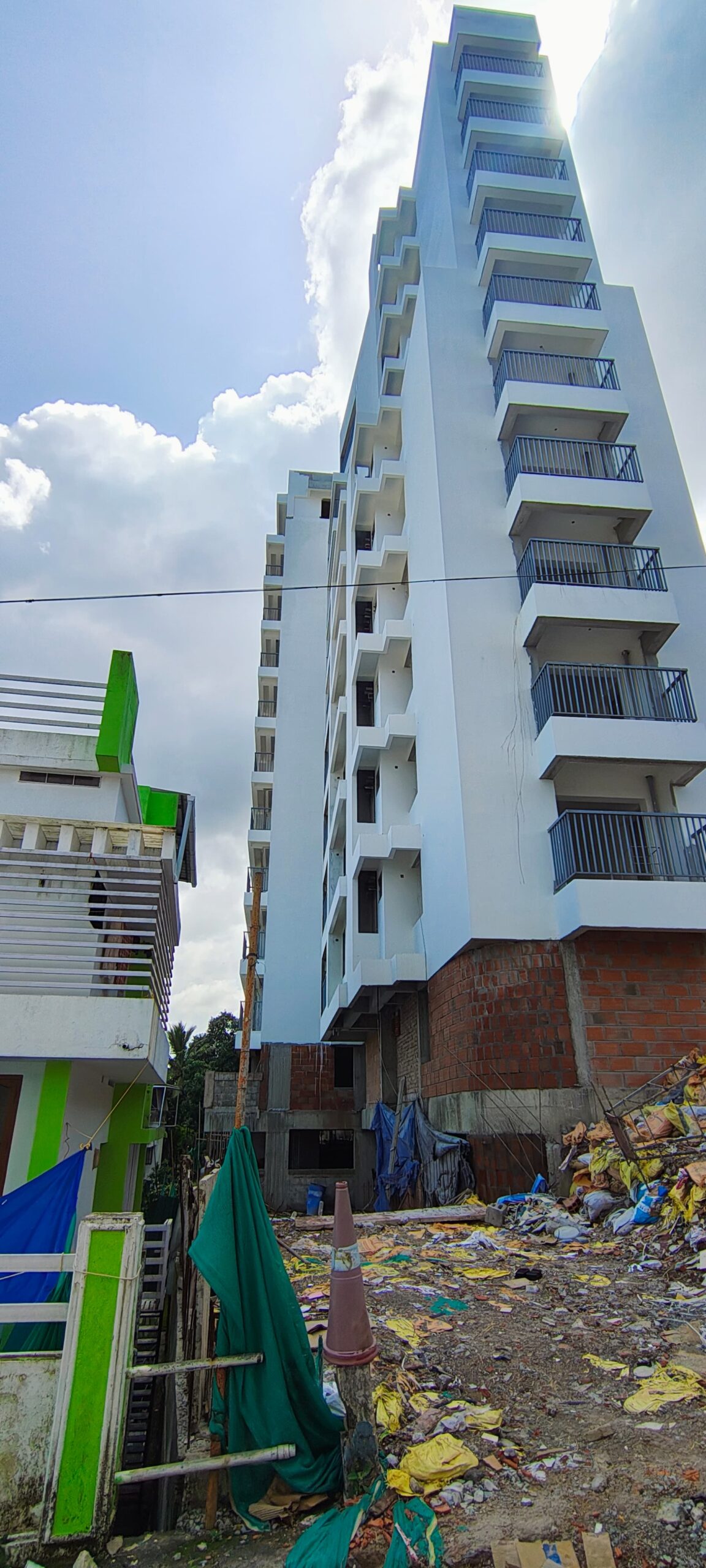

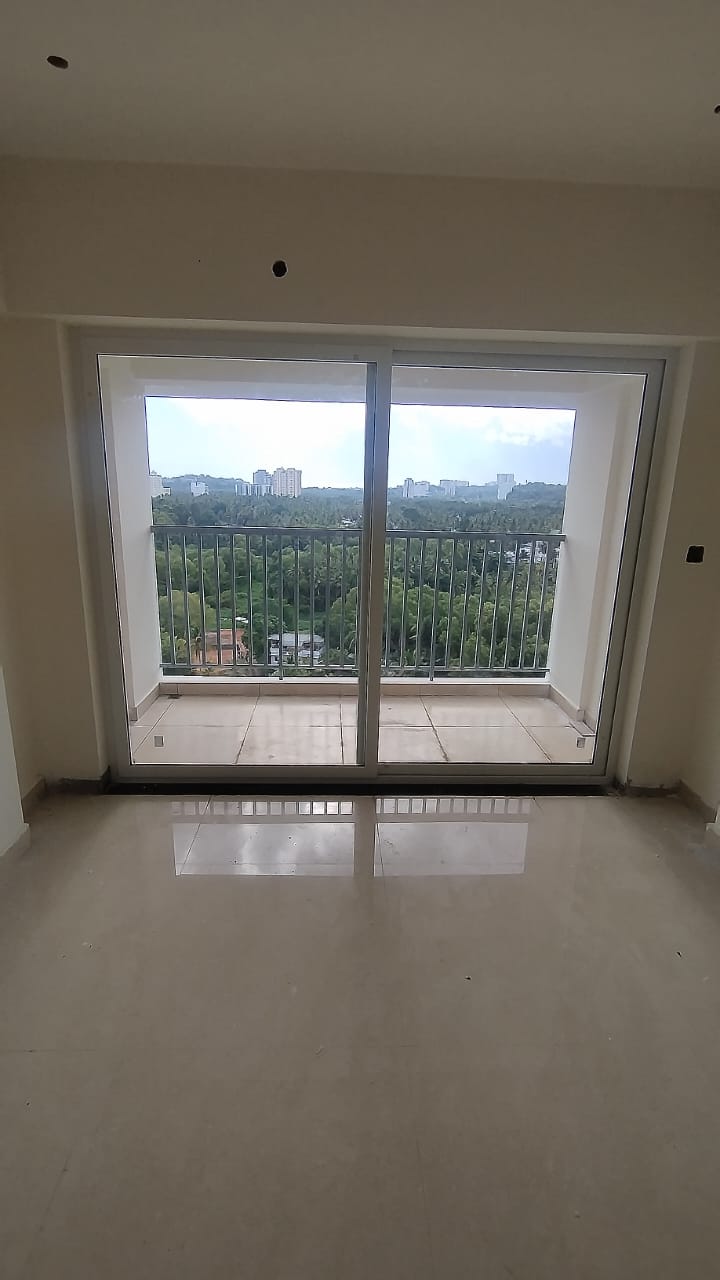

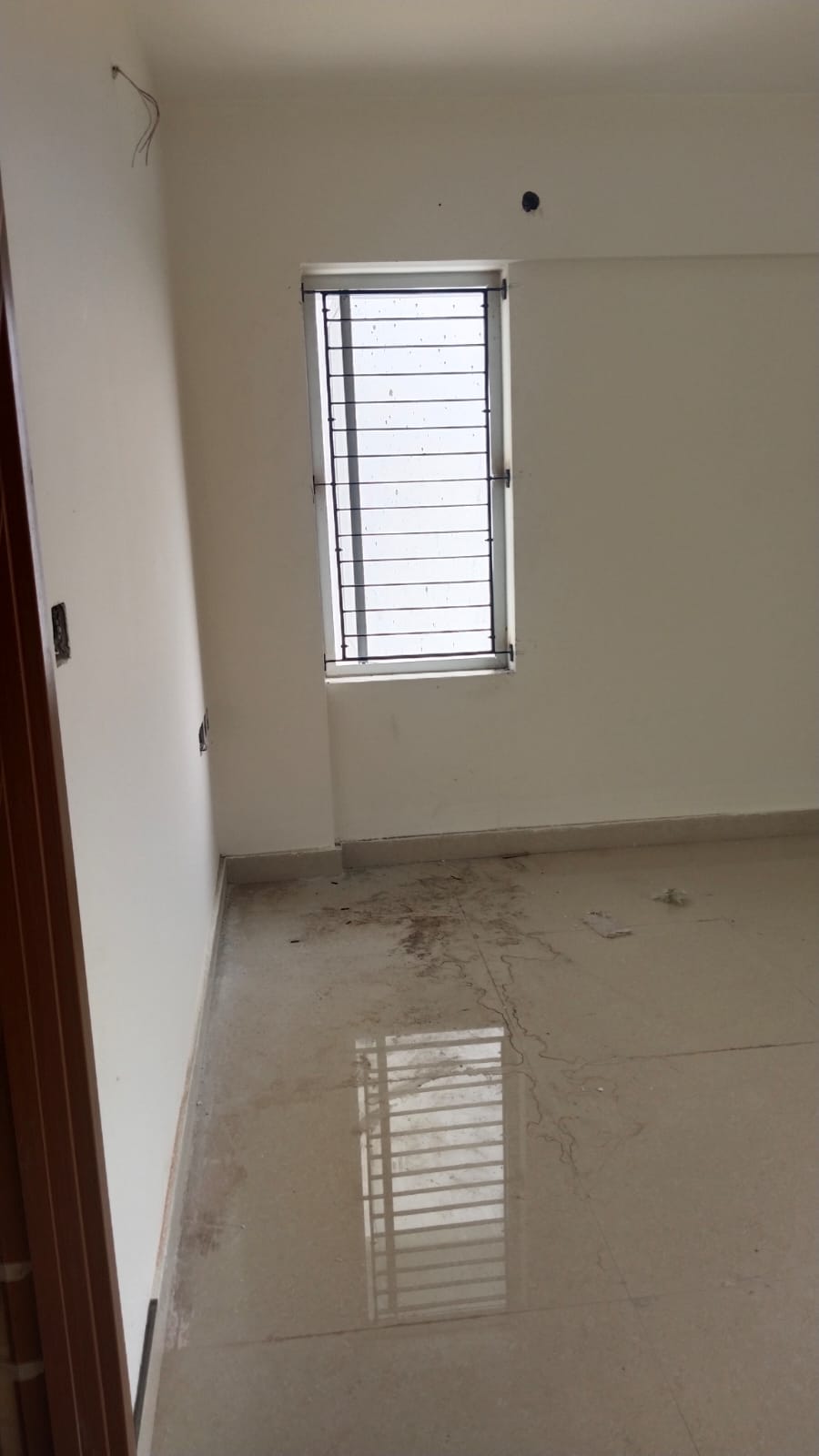

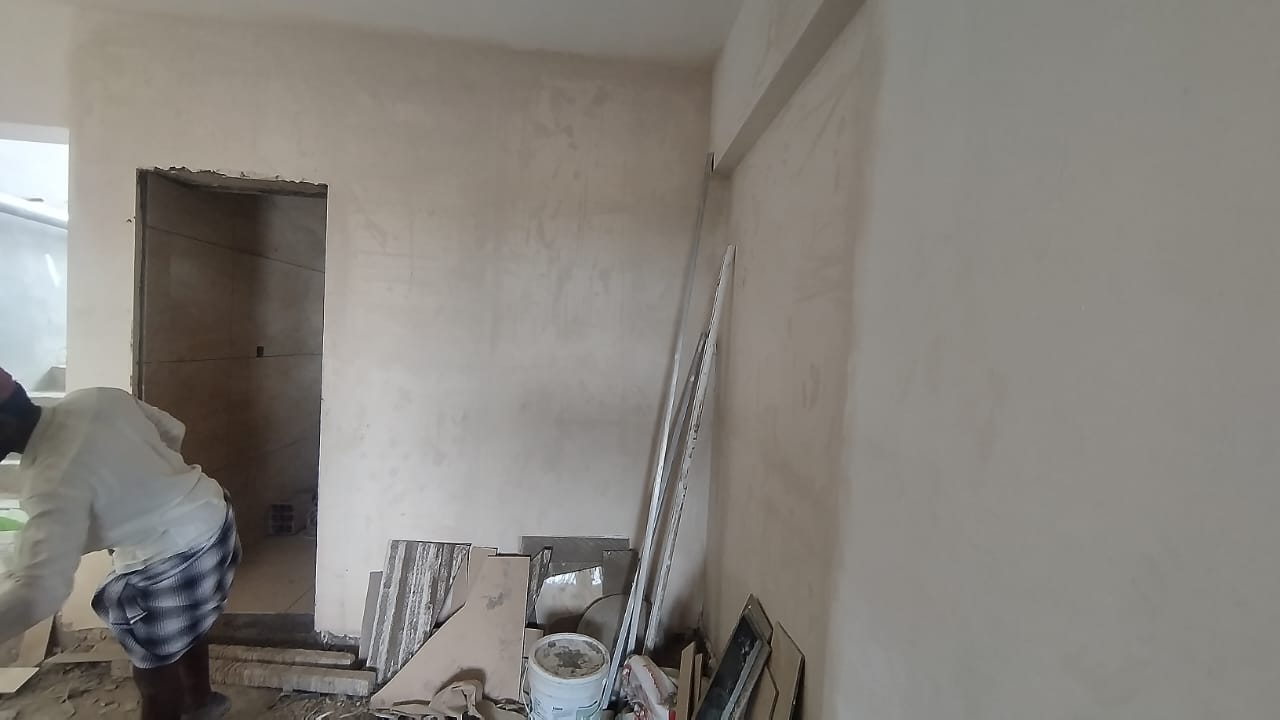

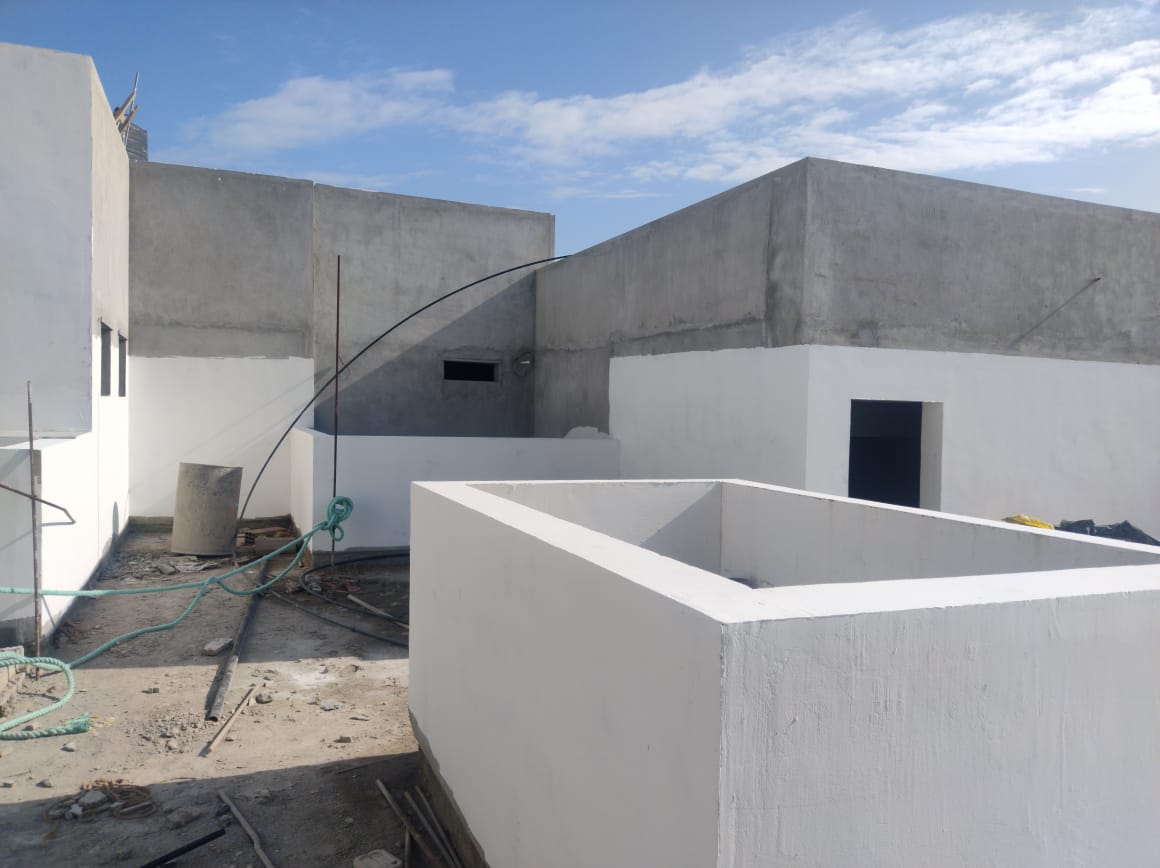

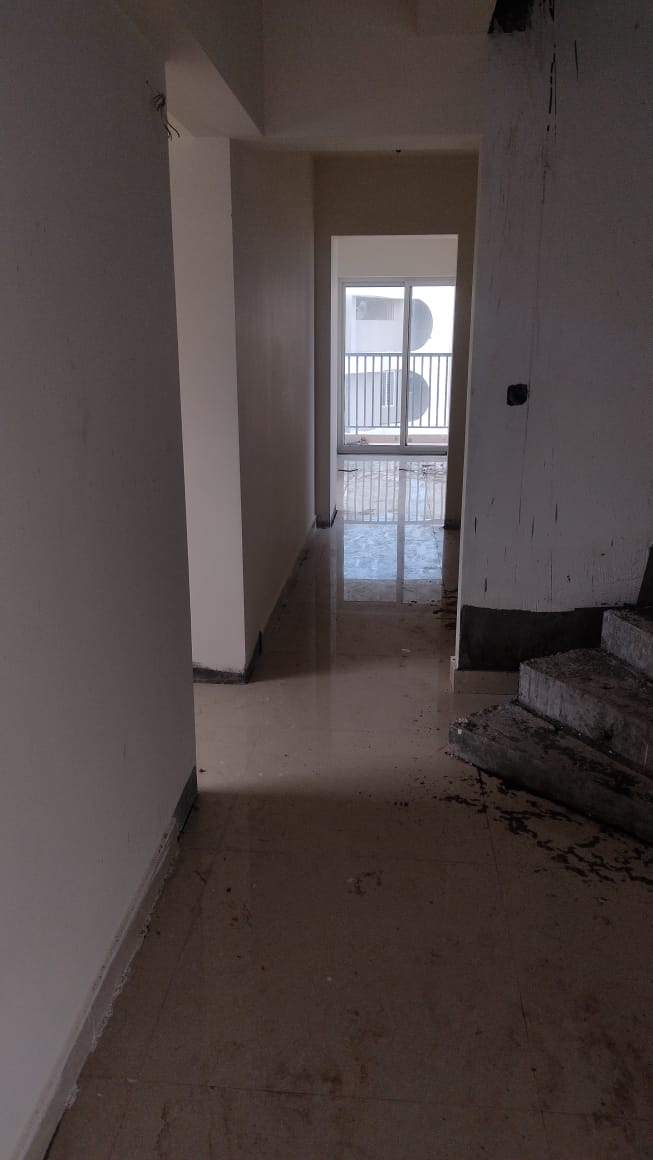

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%,Duplex roof – 100%

WALL Plastering

First Floor to 9th floor- 100%,

Pent House-100%

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing 1st floor- 10th floor-100%

Plumbing Work

1st to 10th floor plumbing work – 100%,

Waterproofing Work

1st to 10th floor waterproofing work – 100%

Painting Work

1st to 9th floor putty work – 100%,

9th to 3rd floor (inside apartment) 1st coat painting-100%
1st & 2nd floor (inside apartment) 1st coat painting-20%

Outside putty work-90%

Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Ninth Floor – 100%

 Tenth Floor-99%

Tile Work

First Floor – 84%

9th floor-100%

8th floor-84%

7th floor-100%

6th floor-100%

5th  floor-84%
4th  floor-84%

3rd  floor-100%

2nd  floor-100%

Core cutting Work

First -10h Floor – 100%

06-07-2025

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%,Duplex roof – 100%

WALL Plastering

First Floor to 9th floor- 100%,

Pent House-100%

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing 1st floor- 10th floor-100%

Plumbing Work

1st to 10th floor plumbing work – 100%,

Waterproofing Work

1st to 10th floor waterproofing work – 100%

Painting Work

1st to 9th floor putty work – 100%,

1st floor painting-20%

Outside putty work-90%

Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Ninth Floor – 100%

 Tenth Floor-99%

Tile Work

First Floor – 66%

9th floor-100%

8th floor-84%

7th floor-68%

6th floor-100%

5th  floor-68%
4th  floor-84%

3rd  floor-100%

2nd  floor-68%

Core cutting Work

First -10h Floor – 100%

05-06-2025

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%,Duplex roof – 100%

WALL Plastering

First Floor to 9th floor- 100%,

Pent House-100%

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing 1st floor- 10th floor-100%

Plumbing Work

1st to 10th floor plumbing work – 100%,

Waterproofing Work

1st to 10th floor waterproofing work – 100%

Painting Work

1st to 9th floor putty work – 100%,

1st floor painting-20%

Outside putty work-70%

Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Ninth Floor – 100%

 Tenth Floor-99%

Tile Work

First Floor – 66%

9th floor-100%

8th floor-84%

7th floor-68%

6th floor-100%

5th &4th floor-68%

Core cutting Work

First -ninth Floor – 100%

08-05-2025

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%,Duplex roof – 100%

WALL Plastering

First Floor to 8th floor- 100%,

9th floor-100%

Pent House-100%

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing 1st floor- 10th floor-100%

Plumbing Work

1st to 10th floor plumbing work – 100%,

Waterproofing Work

1st to 10th floor waterproofing work – 100%

Painting Work

1st to 6th floor putty work – 100%,

7th floor putty work-84%

8th floor putty work-34%

9th floor putty work-100%

1st floor painting-20%

Outside putty work-50%

Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Ninth Floor – 100%

 Tenth Floor-99%

Tile Work

First Floor – 66%

9th floor-66%

8th floor-32%

7th-6th floor-40%

5th floor-15%

Core cutting Work

First -ninth Floor – 100%

02-04-2025

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%,Duplex roof – 100%

WALL Plastering

First Floor to 8th floor- 100%,

9th floor-100%

Pent House-100%

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing upto 4th floor- 10th floor-100%

Plumbing Work

1st to 10th floor plumbing work – 100%,

Waterproofing Work

1st to 10th floor waterproofing work – 100%

Painting Work

1st to 6th floor putty work – 100%,

7th floor putty work-84%

8th floor putty work-34%

9th floor putty work-66%

1st floor painting-20%

Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Ninth Floor – 100%

 Tenth Floor-99%

Tile Work

First Floor – 66%

9th floor-66%

8th floor-32%

Core cutting Work

First -ninth Floor – 100%

04-03-2025

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%, Duplex roof – 100%

WALL Plastering

First Floor to 8th floor- 100%,

9th floor-100%

10th floor-90%

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing upto 4th floor- 10th floor-100%

Plumbing Work

1st to 5th floor plumbing work – 100%,

6th floor plumbing work-75%

7th-9th floor plumbing work-100%

Waterproofing Work

1st to 9th floor waterproofing work – 100%

Painting Work

1st to 6th floor putty work – 100%,

1st floor painting-20%

Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Ninth Floor – 100%

 Tenth Floor-99%

Tile Work

First-Seventh Floor – 70%

Core cutting Work

First -ninth Floor – 100%

07-02-2025

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%,Duplex roof – 100%

WALL Plastering

First Floor to 8th floor- 100%,

9th floor-100%

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing upto 4th floor- 9th floor-100%

10th floor-40%

Plumbing Work

1st to 8TH floor plumbing work – 100%,9th floor-50%

Waterproofing Work

1st to 8th floor waterproofing work – 100%

Painting Work

1st to 4th floor putty work – 100%,5TH floor-50%

1st floor painting-20%

Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Ninth Floor – 100%

 Tenth Floor-80%

Tile Work

First-Seventh Floor – 70%

Core cutting Work

First -Eighth Floor – 100%

Ninth Floor – 90%

03-01-2025

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%, Duplex roof – 100%

WALL Plastering
First Floor to 8th floor- 100%,
9th floor-15%

Electrical Work

Upto 10th floor rope pulling – 100%

Wall chasing upto 4th floor- 8th floor-100%

Plumbing Work

1st to 5TH floor plumbing work – 100%,6th floor-80%

Waterproofing Work

1st to 3rd floor waterproofing work – 100%,4 th floor-50%

Painting Work

1st to 3rd floor putty work – 100%,4TH floor-50%
1st floor painting-20%

Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Eighth Floor – 80%

Tile Work

First Floor – 20%

Core cutting Work

First -Seventh Floor – 100%

Eighth Floor – 50%

05-12-2024

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 9th floor- 100%, Duplex roof – 100%

WALL Plastering
First Floor to 6th floor- 100%,

Seventh Floor – 90%

Electrical Work

Upto 8th floor rope pulling – 100%

Wall chasing upto 4th floor- 100%, 5th floor – 35%, 6th floor&7th -100% ,8th floor-60%

Plumbing Work

1st to 3rd floor plumbing work – 100%,4 th floor-80%

Waterproofing Work

1st to 3rd floor waterproofing work – 100%,4 th floor-25%

Painting Work

1st to 2nd floor putty work – 100%,3rd floor-90%

Block work

First Floor – 100%

Second Floor – 100%

Third floor – 100%

Fourth Floor – 100%

Fifth Floor – 100%

Sixth floor – 100%

Seventh Floor – 100%

Eighth Floor – 100%

Core cutting Work

First -fifth Floor – 100%

SixthFloor – 20%

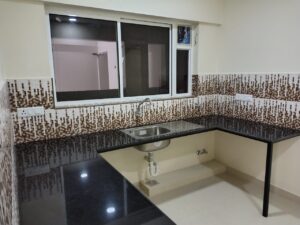

Sample Apartment Work

Entire work -100%

08-11-2024

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%, Duplex roof – 100%

Ceiling Plastering

First Floor to 7th floor- 100%

Eighth Floor – 100%

Electrical Work

Upto 8th floor rope pulling – 100%

Wall chasing upto 4th floor- 100%, 5th floor – 35%, 6th floor -85%

Block work

First Floor – 95%

Second Floor – 95%

Third floor – 95%

Fourth Floor – 95%

Fifth Floor – 95%

Sixth floor – 95%

Seventh Floor – 90%

Eighth Floor – 50%

Waterproofing work

First Floor – 100%

Second Floor – 100%

Core cutting Work

First Floor – 100%

Second Floor – 100%

Third Floor – 100%

 Sample Apartment Work

Entire work -100%

03-10-2024

Piling work – 100%

Pile cap work – 100%

Floor slab Work

Lower basement to 10th floor slab – 100%

Ceiling Plastering

First Floor to 7th floor- 100%

Eighth Floor – 80%

Electrical Work

Upto 6th floor rope pulling – 100%

Wall chasing upto 4th floor- 100%, 5th floor – 35%

Block work

First Floor – 95%

Second Floor – 95%

Third floor – 95%

Fourth Floor – 95%

Fifth Floor – 95%

Sixth floor – 95%

Seventh Floor – 90%

Waterproofing work

First Floor – 100%

06-06-2024

Piling Work – 100%

Pile Cap Work – 100%

Floor Slab Work
Lower basement to 7th floor slab – 100%

Column Work
Up to 7th floor column – 70%

Ceiling Plastering

1st to 3rd Floor – 100%

4th Floor – 70%

Electrical Work

Upto 3rd floor rope pulling – 100%

4th floor – 70%

Block work

First Floor – 95%

Second Floor – 95%

04-05-2024

Piling Work – 100%

Floor Slab Work
Lower basement to 6th floor slab – 100%

7th floor slab – 50%

Column Work
Up to 6th floor column – 100%

Ceiling Plastering

First Floor- 100%

Second Floor – 100%

Third floor – 70%

Electrical Work
Upto 3rd floor rope pulling – 100%

Block work
First Floor – 95%

27-03-2024

Piling Work – 100%

Pile Cap Work – 100%

Lower Basement to 6th Floor Slab – 100%

6th Floor Column – 30%

Ceiling Plastering (2nd Floor) – 100%

06-02-2024

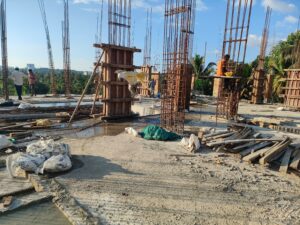

Piling Work – 100%

Pile Cap Work – 100%

Retaining Wall Work (Lower Basement) – 100%

First Floor Slab – 100%

Second Floor Slab – 100%

Upper Basement Floor Slab – 100%

Ground Floor Column – 100%

Second Floor Column – 100%

Ground Floor Slab – 100%

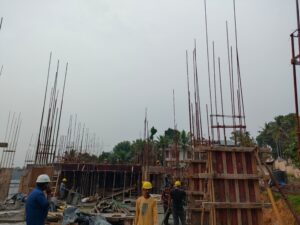

07-12-2023

Piling Work – 100%

Pile Cap Work – 100%

Retaining Wall Work (Lower Basement) – 100%

First Floor Slab – 100%

Second Floor Slab – 100%

Upper Basement Floor Slab – 100%

Ground Floor Column – 100%

Second Floor Column – 100%

Ground Floor Slab – 100%

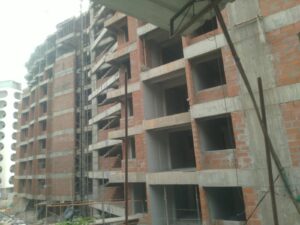

15-11-2023

Piling Work – 100%

Pile Cap Work – 100%

Retaining Wall Work (Lower Basement) – 100%

First Floor Slab – 100%

Second Floor Slab – Shuttering and steel work on going

Upper Basement Floor Slab – 100%

Ground floor Column – 100%

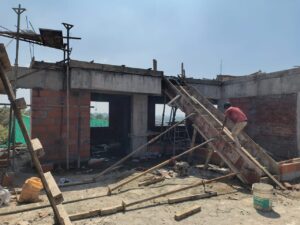

06-07-2023

Piling Work – 100%

Pile Cap Work – 71%

Retaining Wall Work – 49%

Lower Basement Slab – 44%

Lower Basement Column – 71%

Upper Basement Column – 48%

Arcon Exotica - Bhoomi Pooja Ceremony 16.05.2022

Project Status
